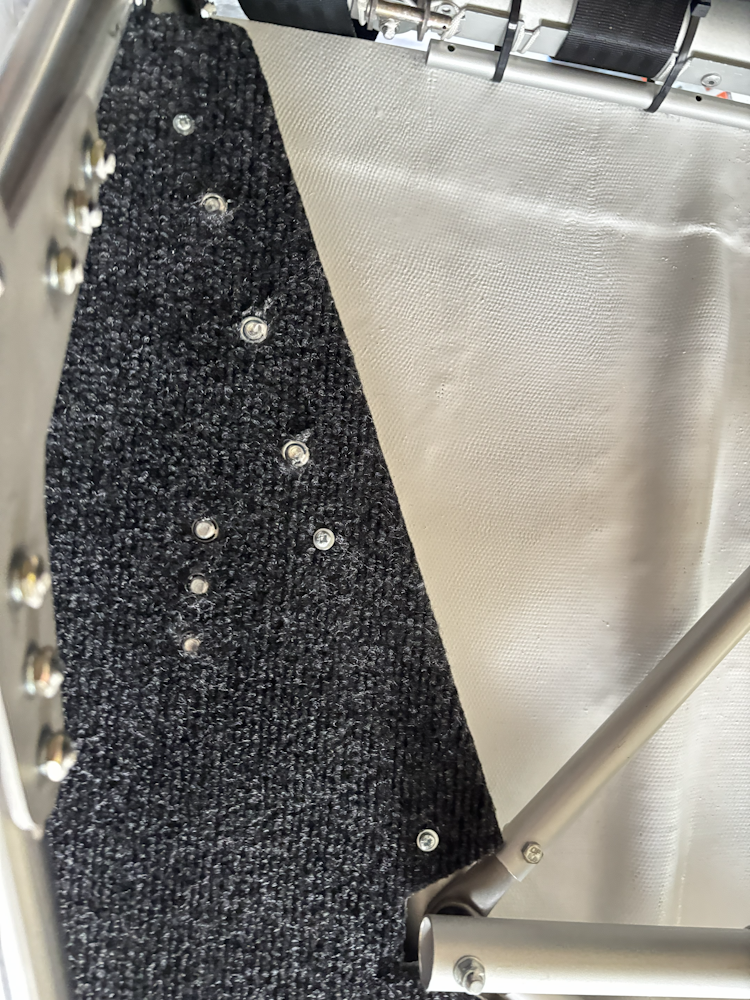

Bushcat Build Log

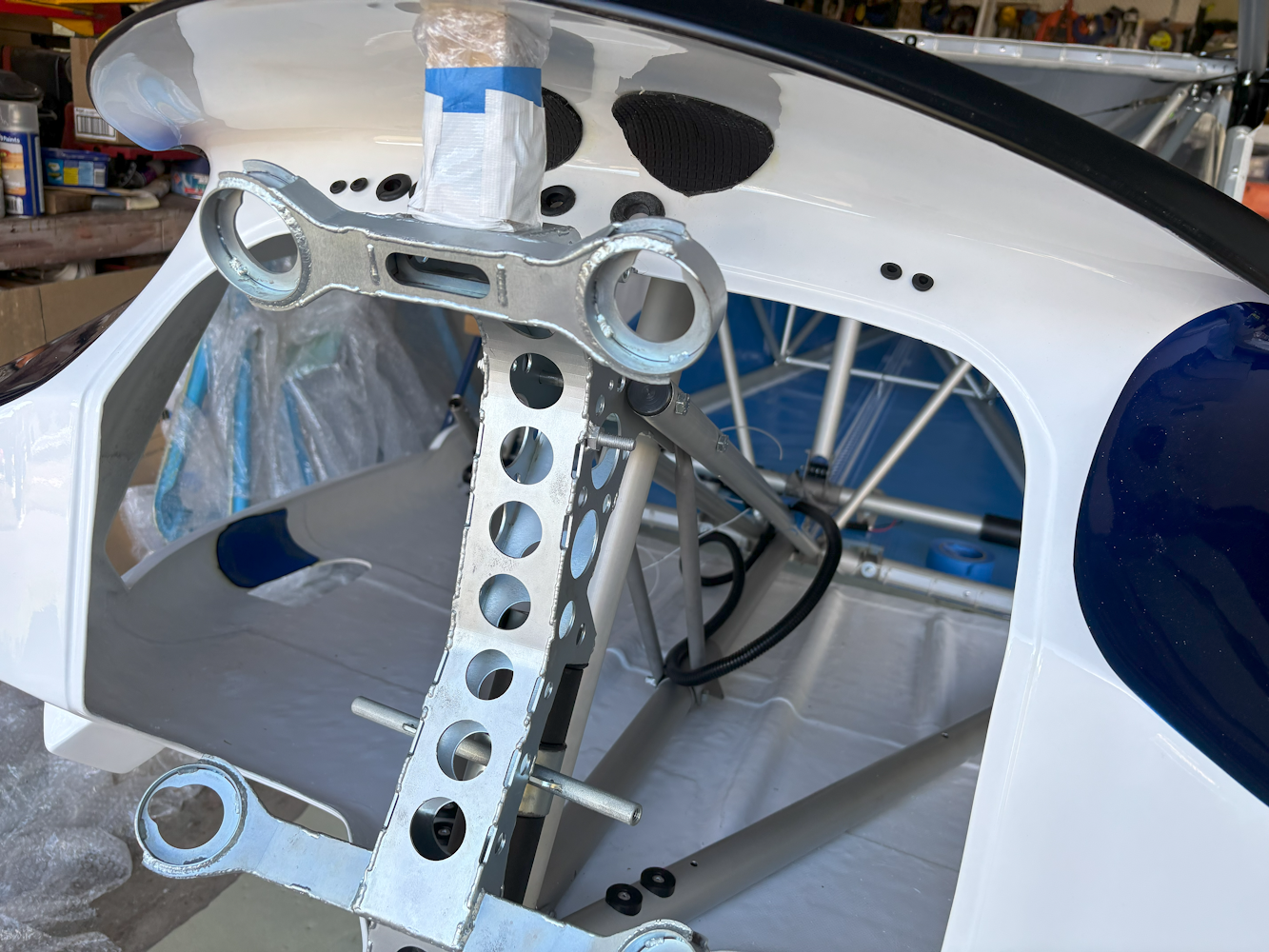

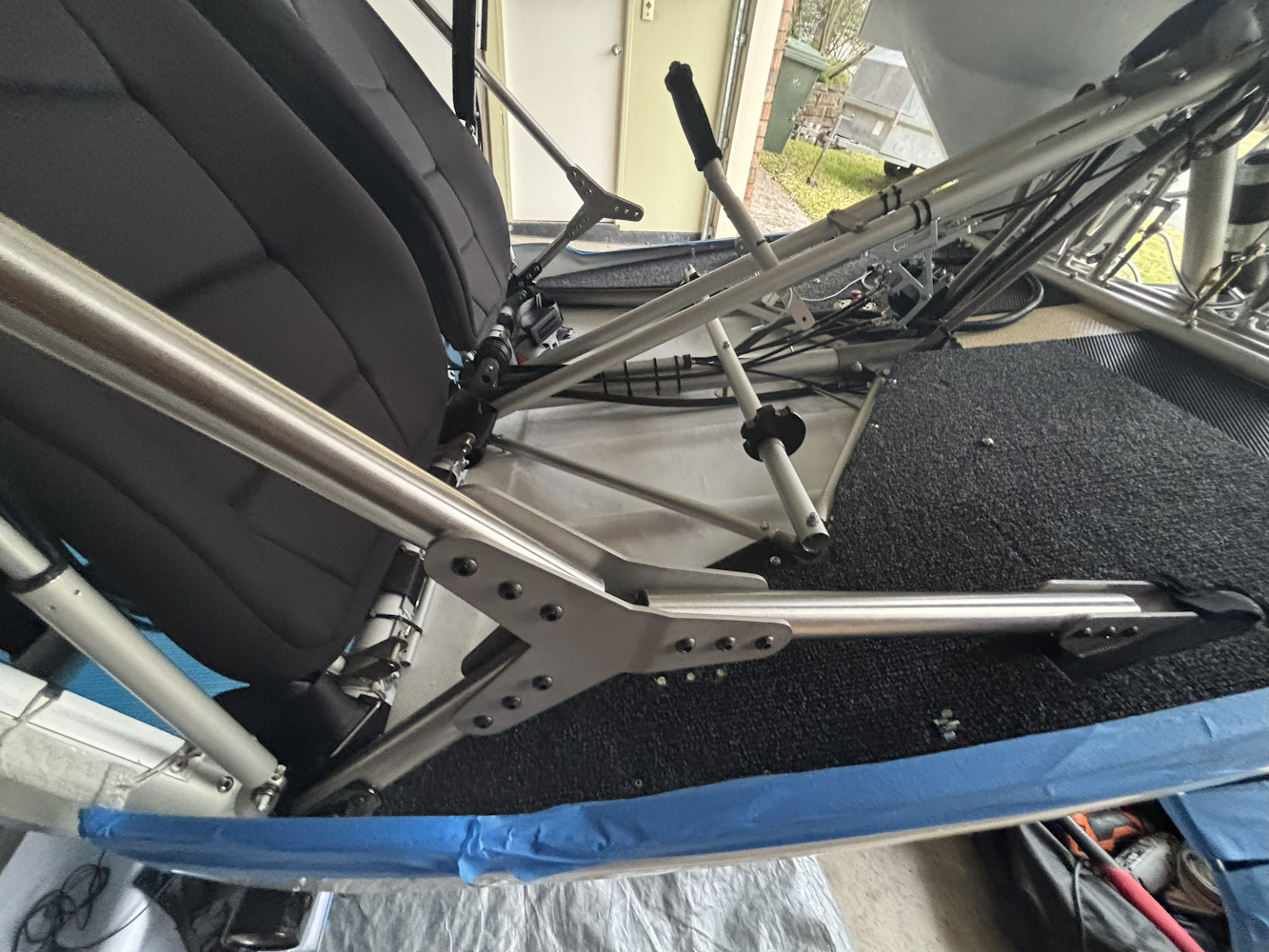

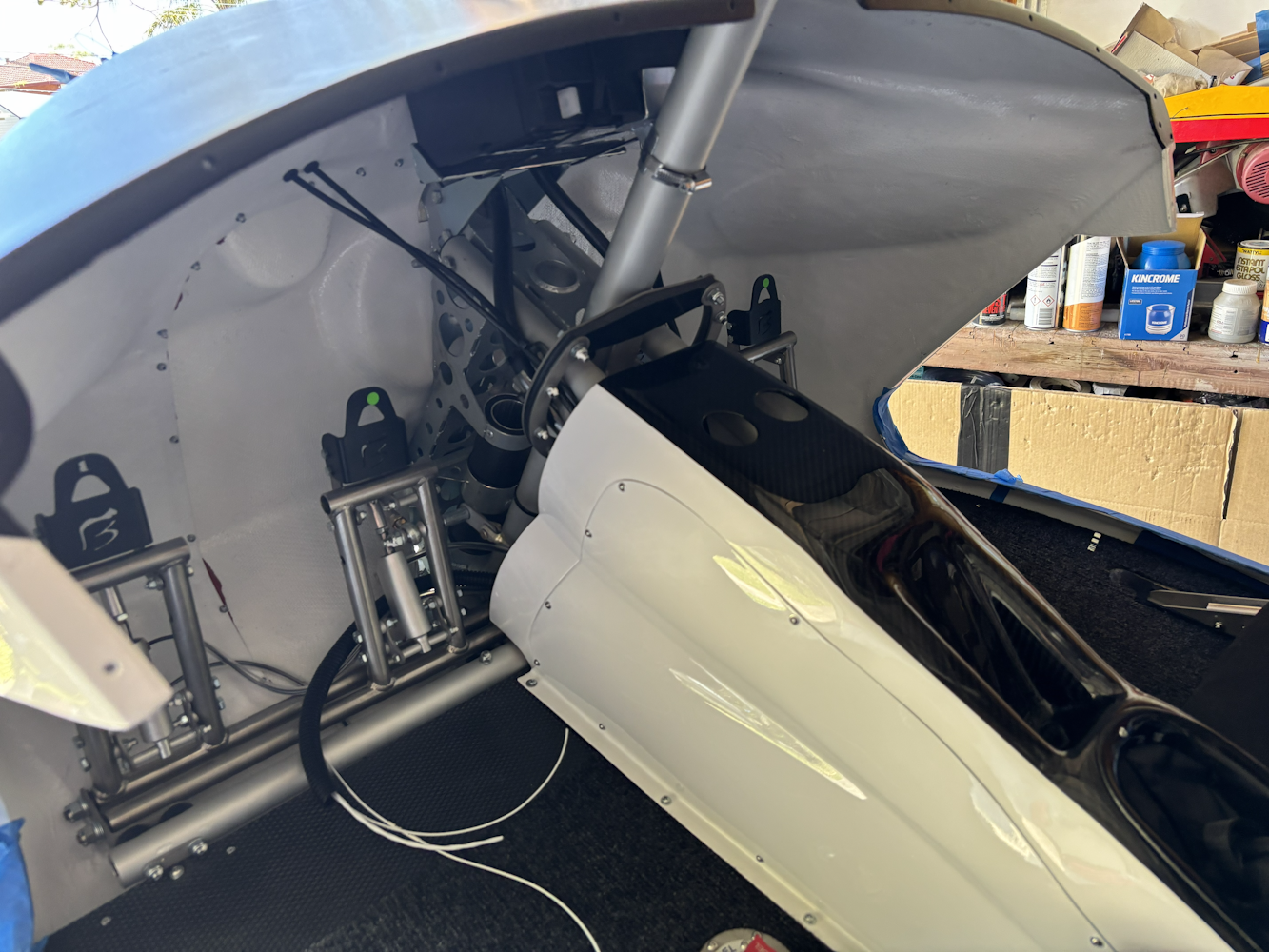

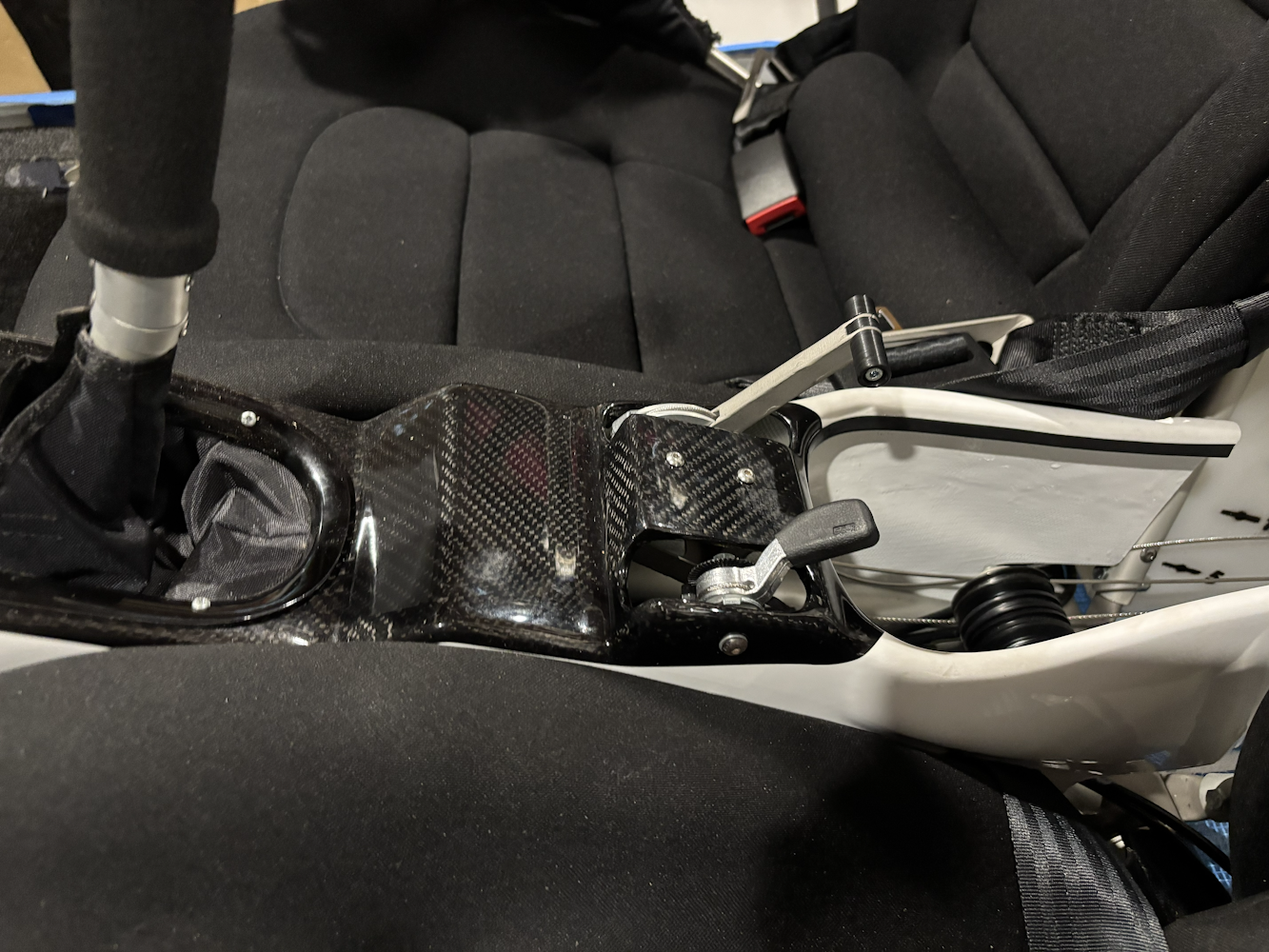

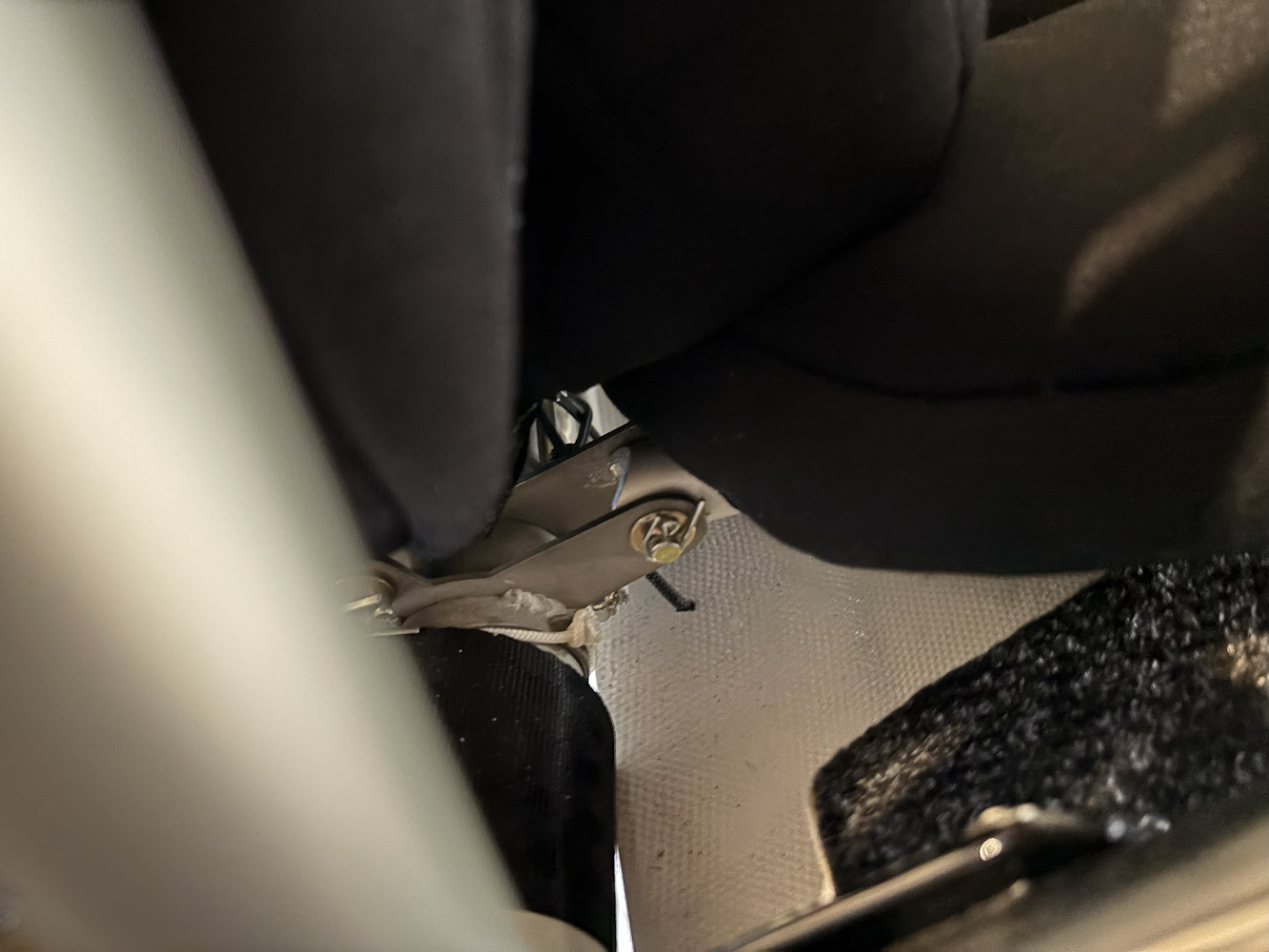

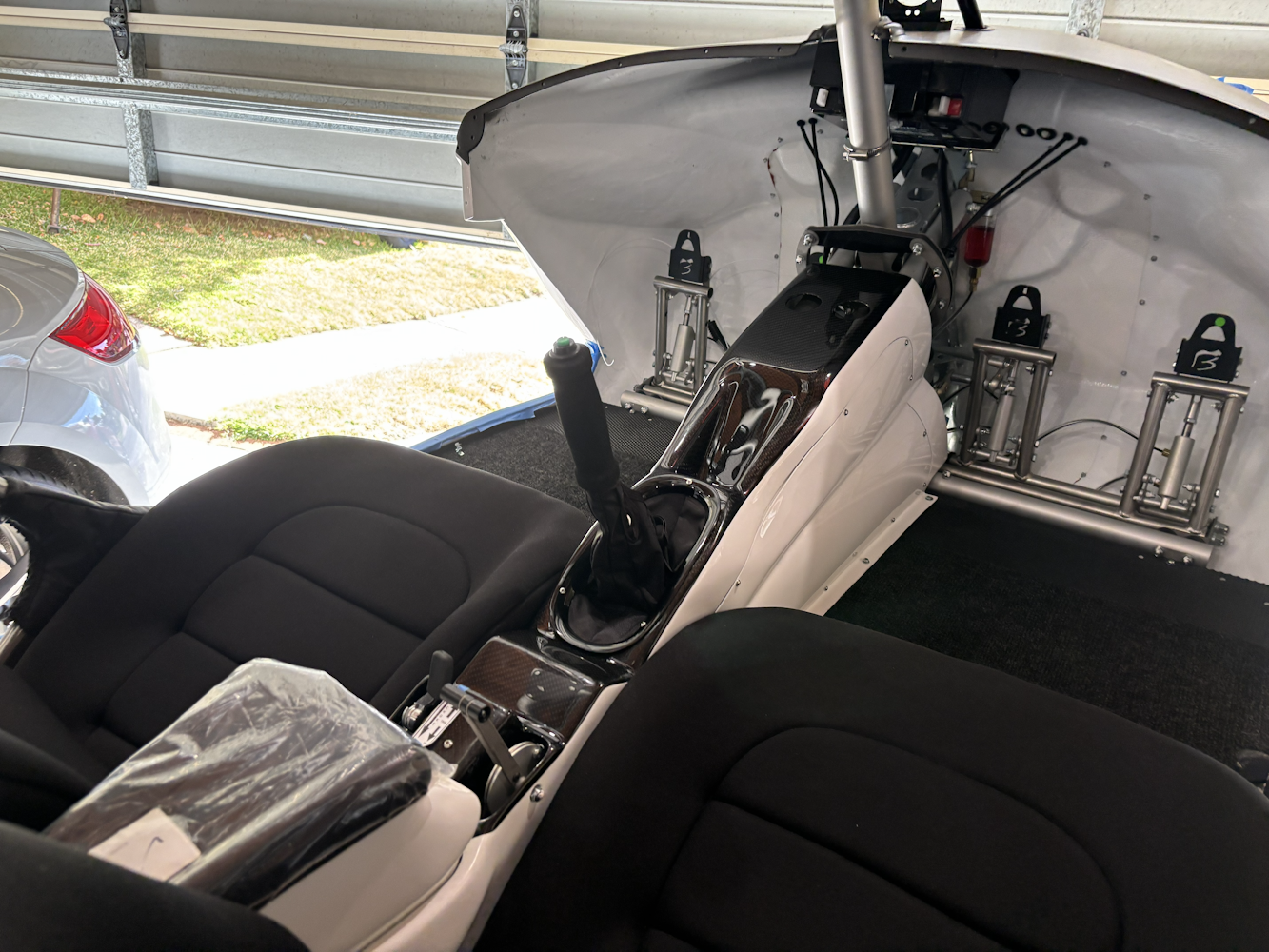

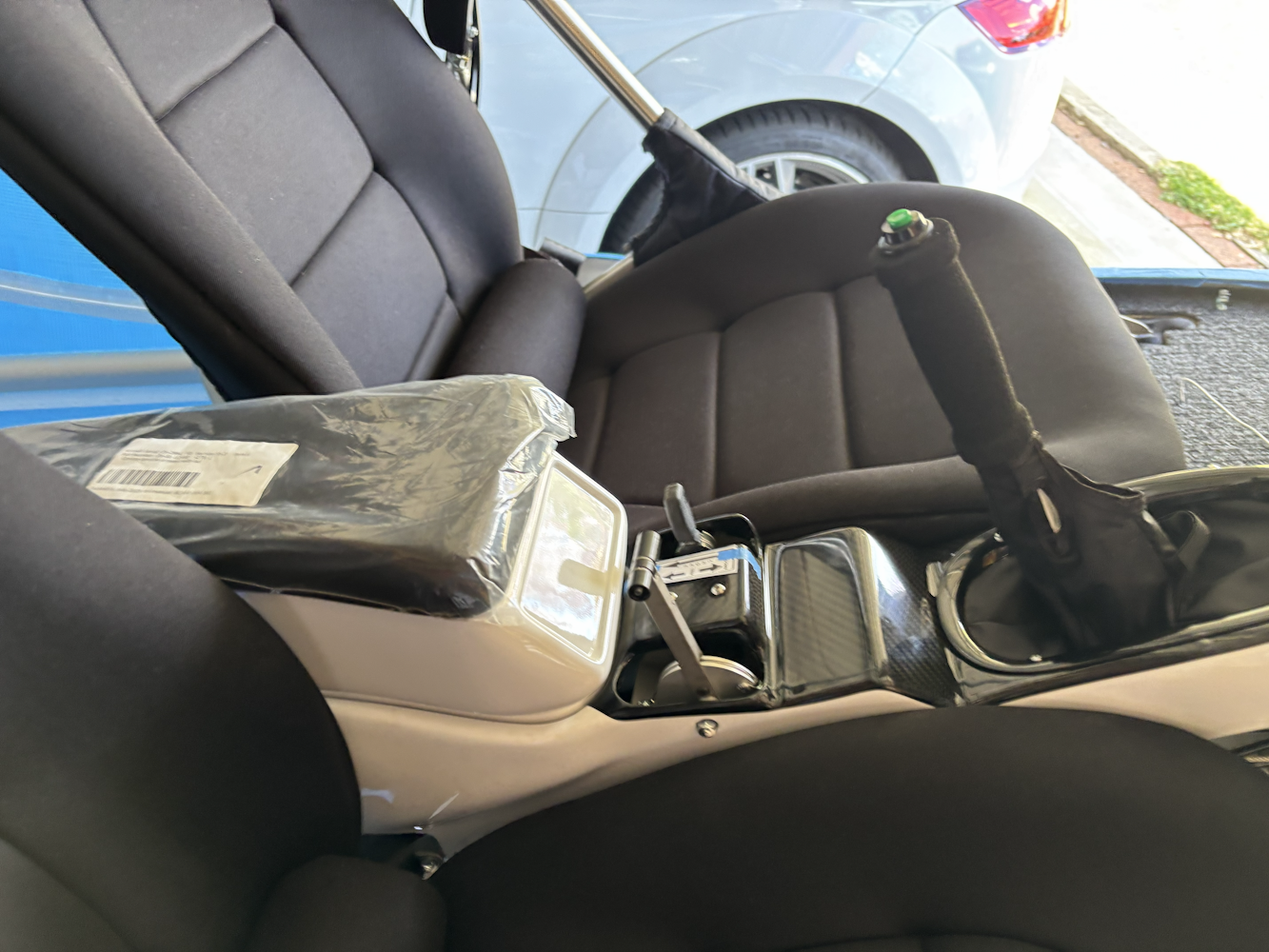

  • LOWER FUSELAGE CENTRE BRACKET

    Aircraft: Bushcat 19-2226
    Task Date: 21/04/2025
    Builder: Malcolm Hardy
    Category: Fuselage
    Section: 1.2
    Hours: 0.5 hr

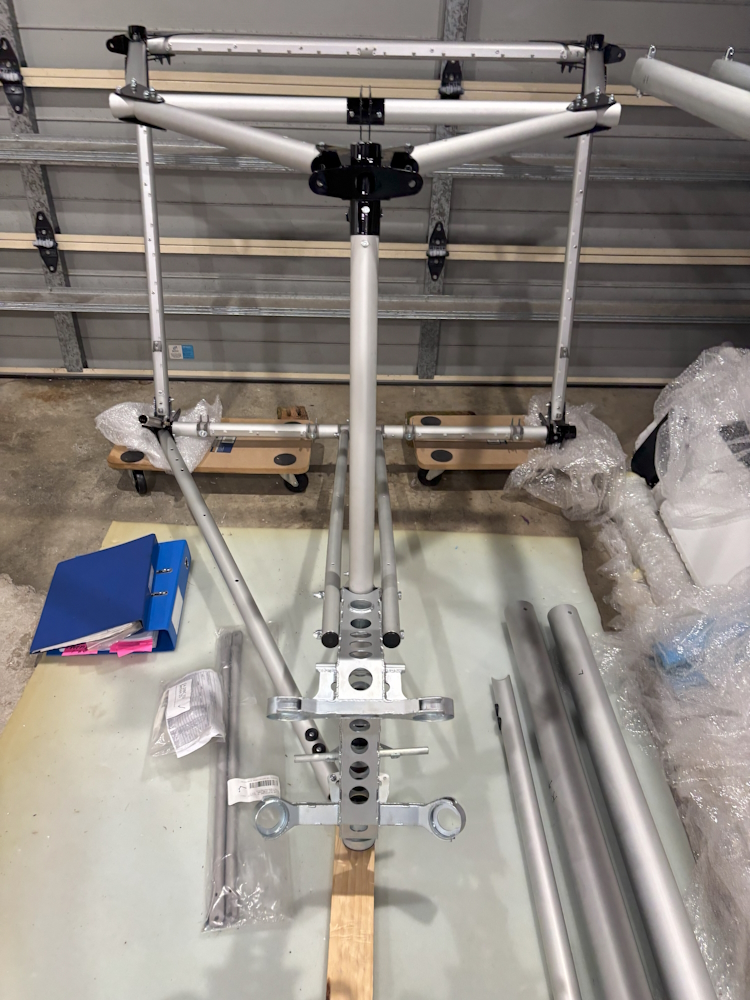

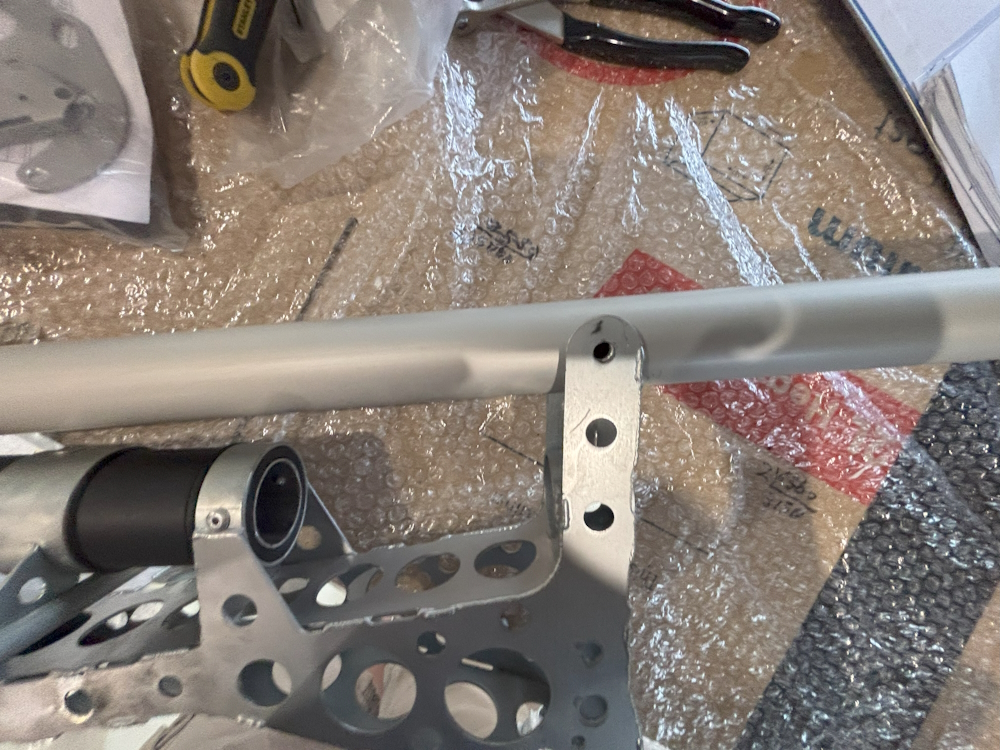

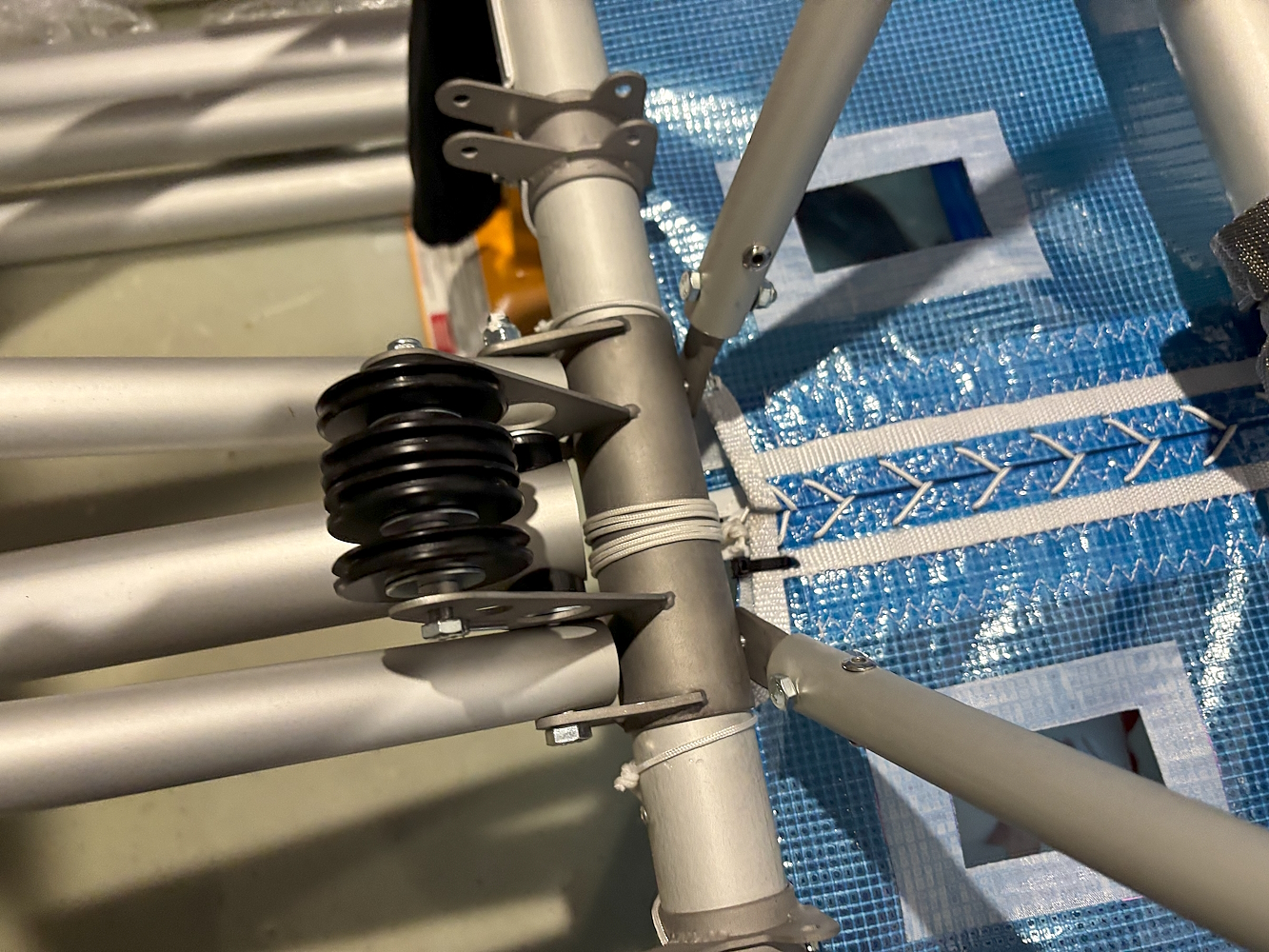

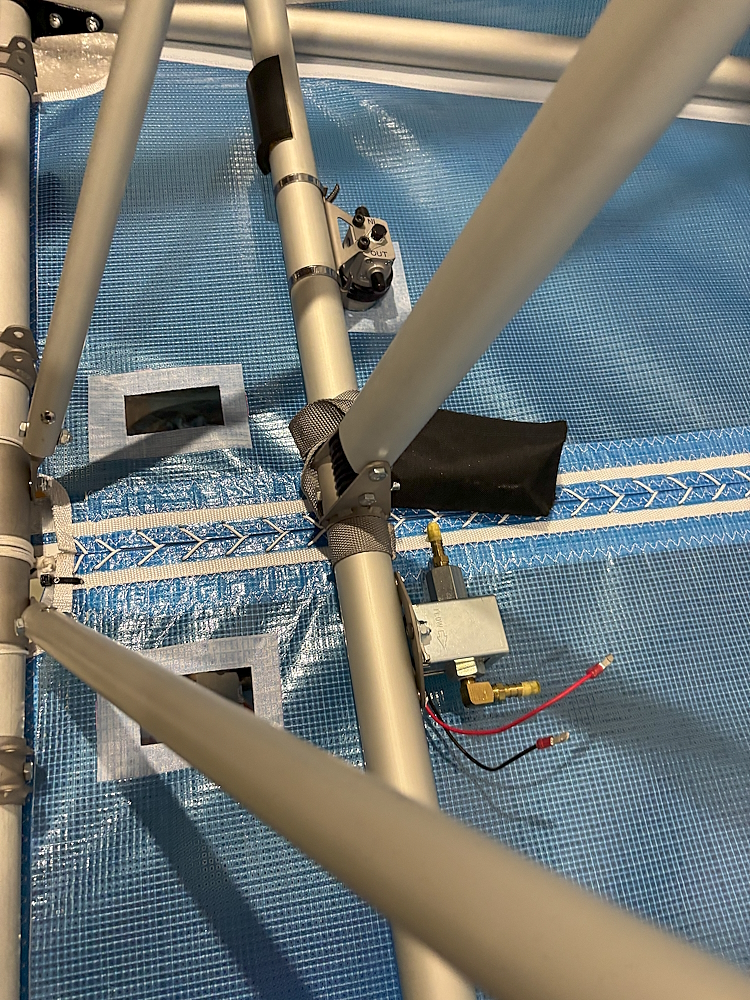

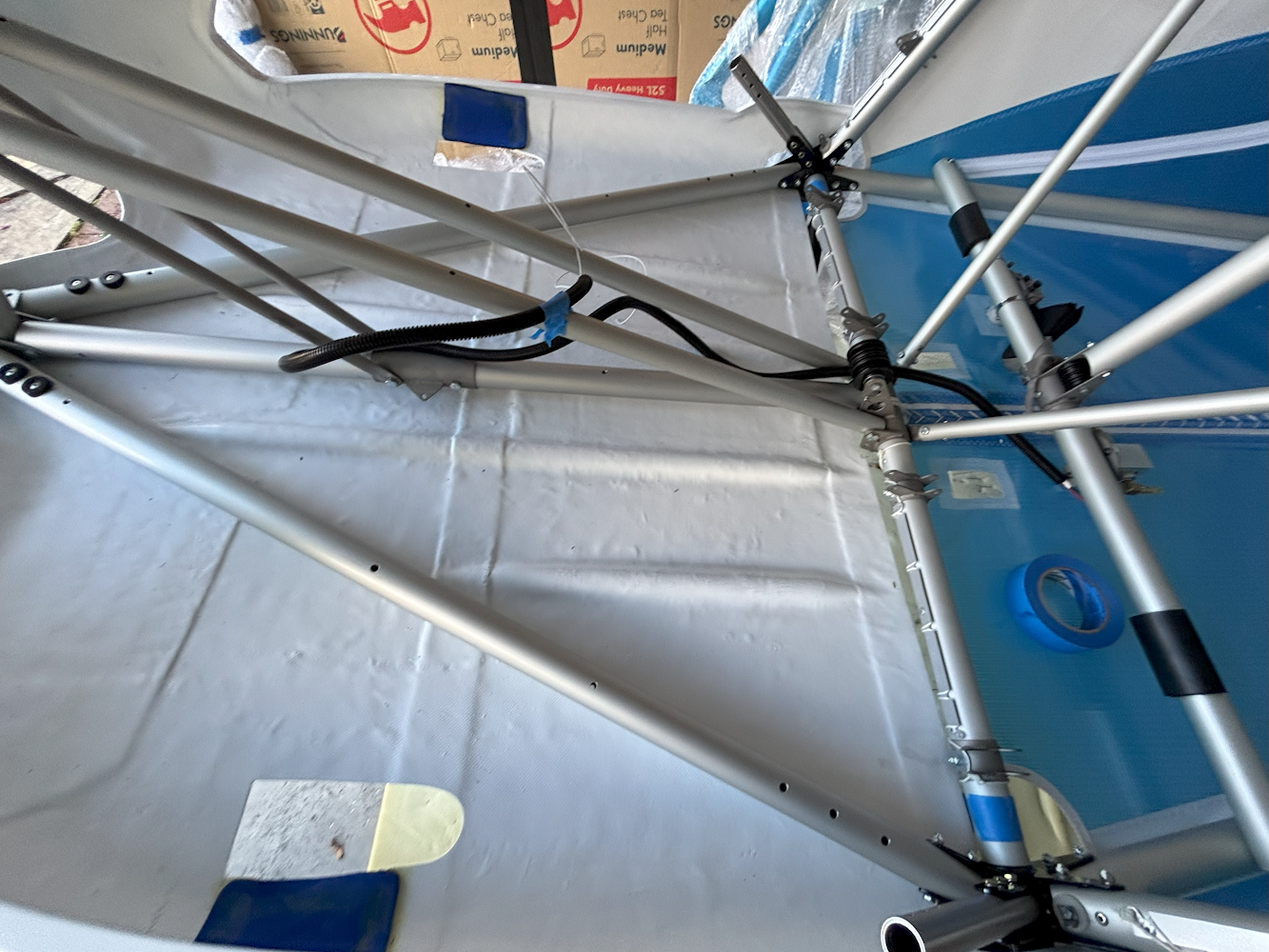

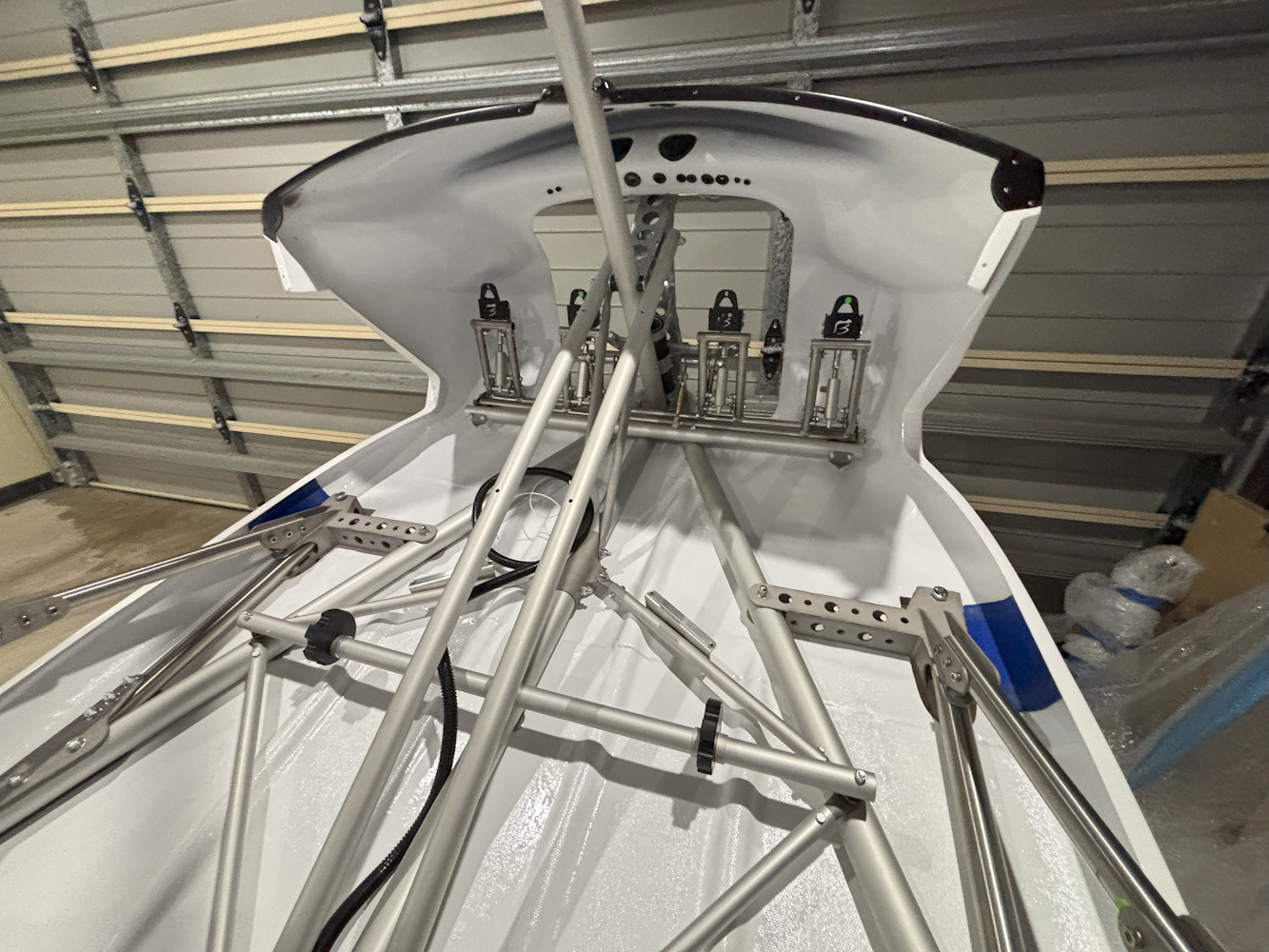

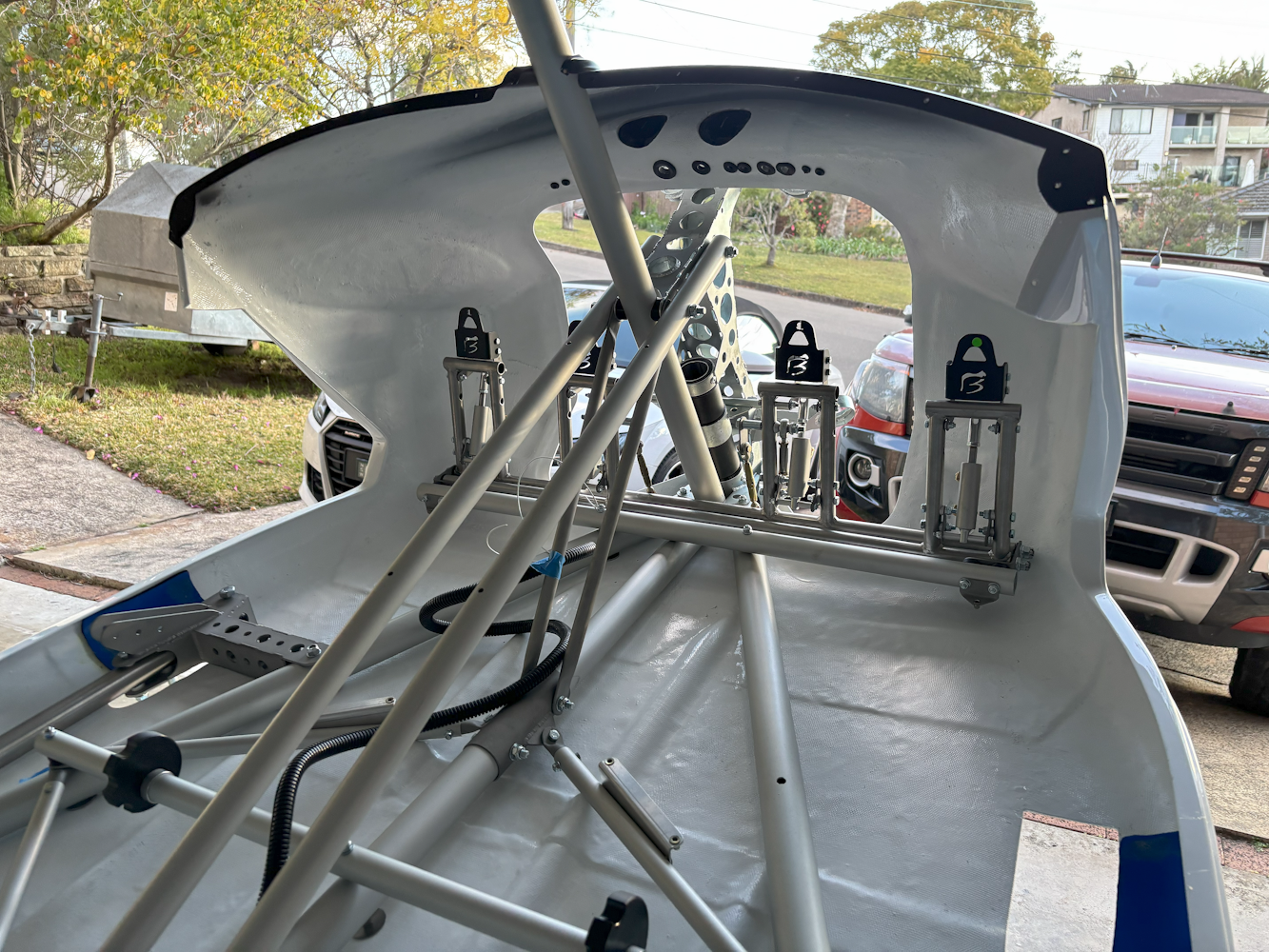

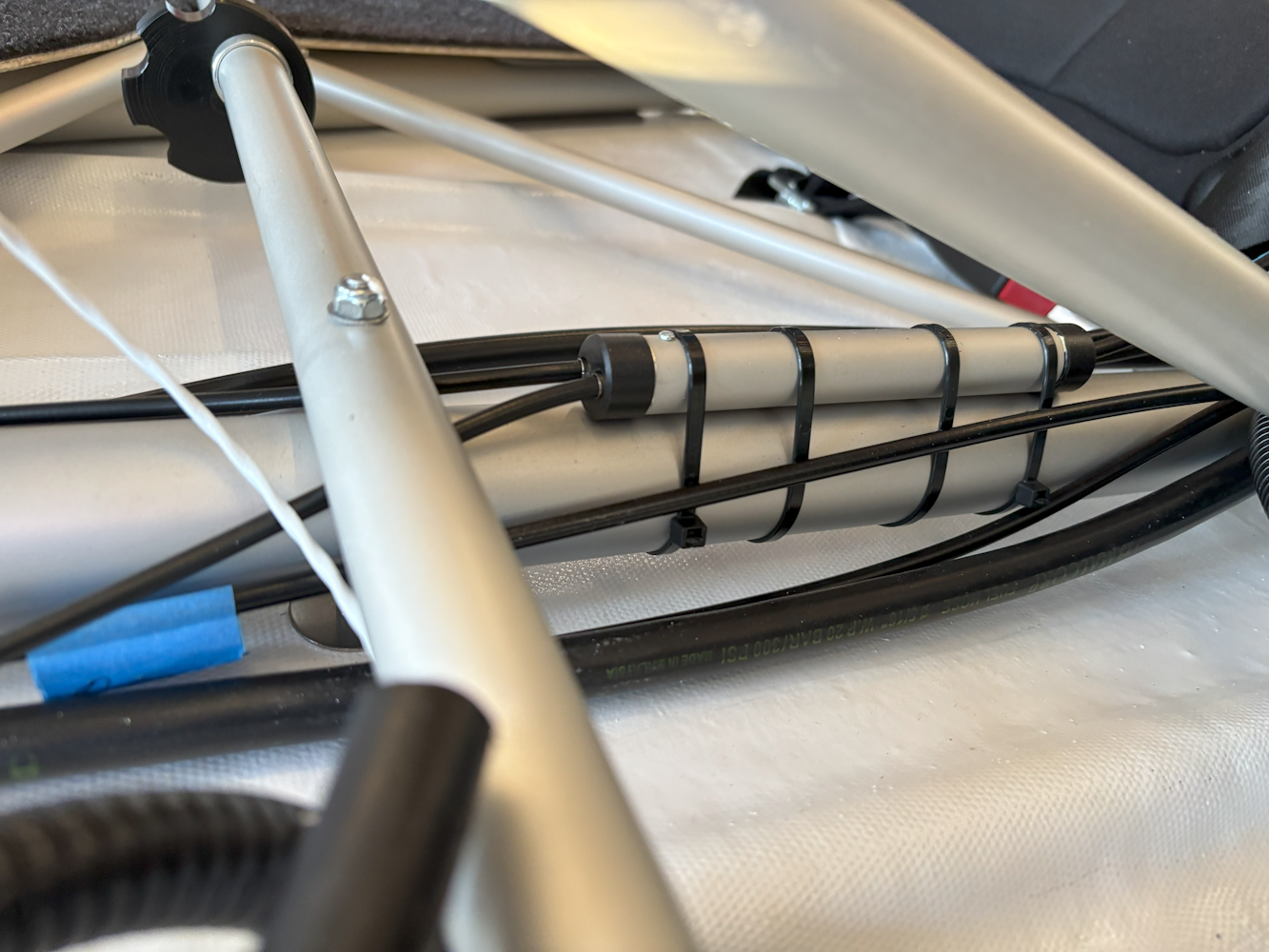

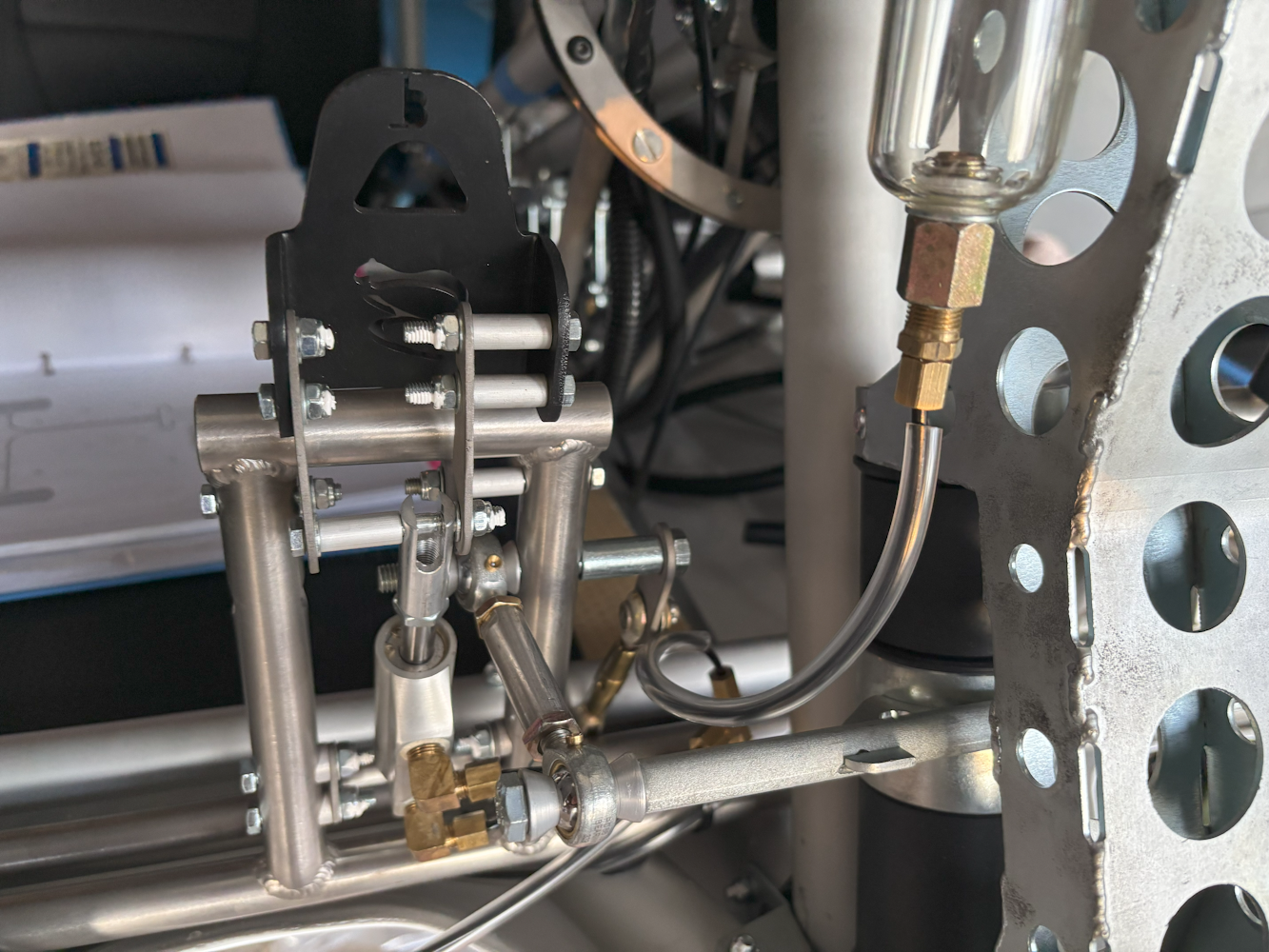

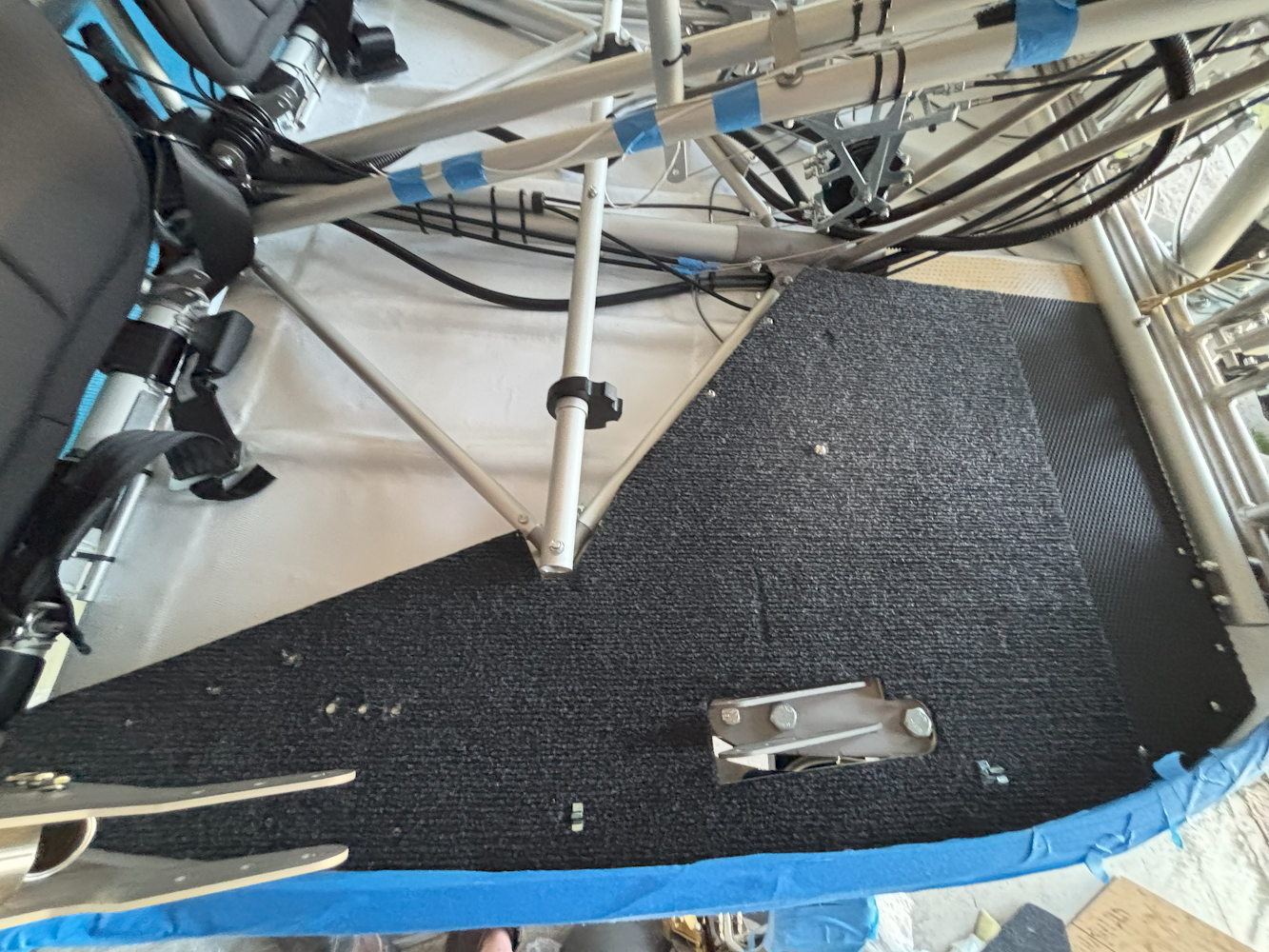

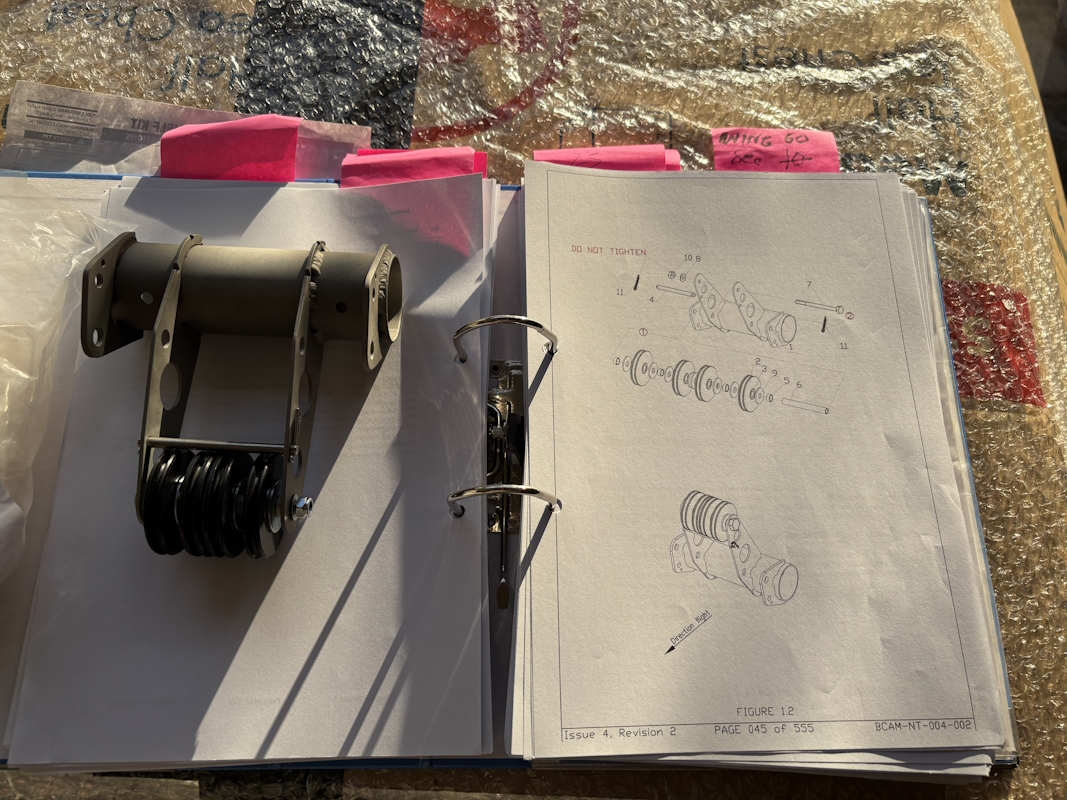

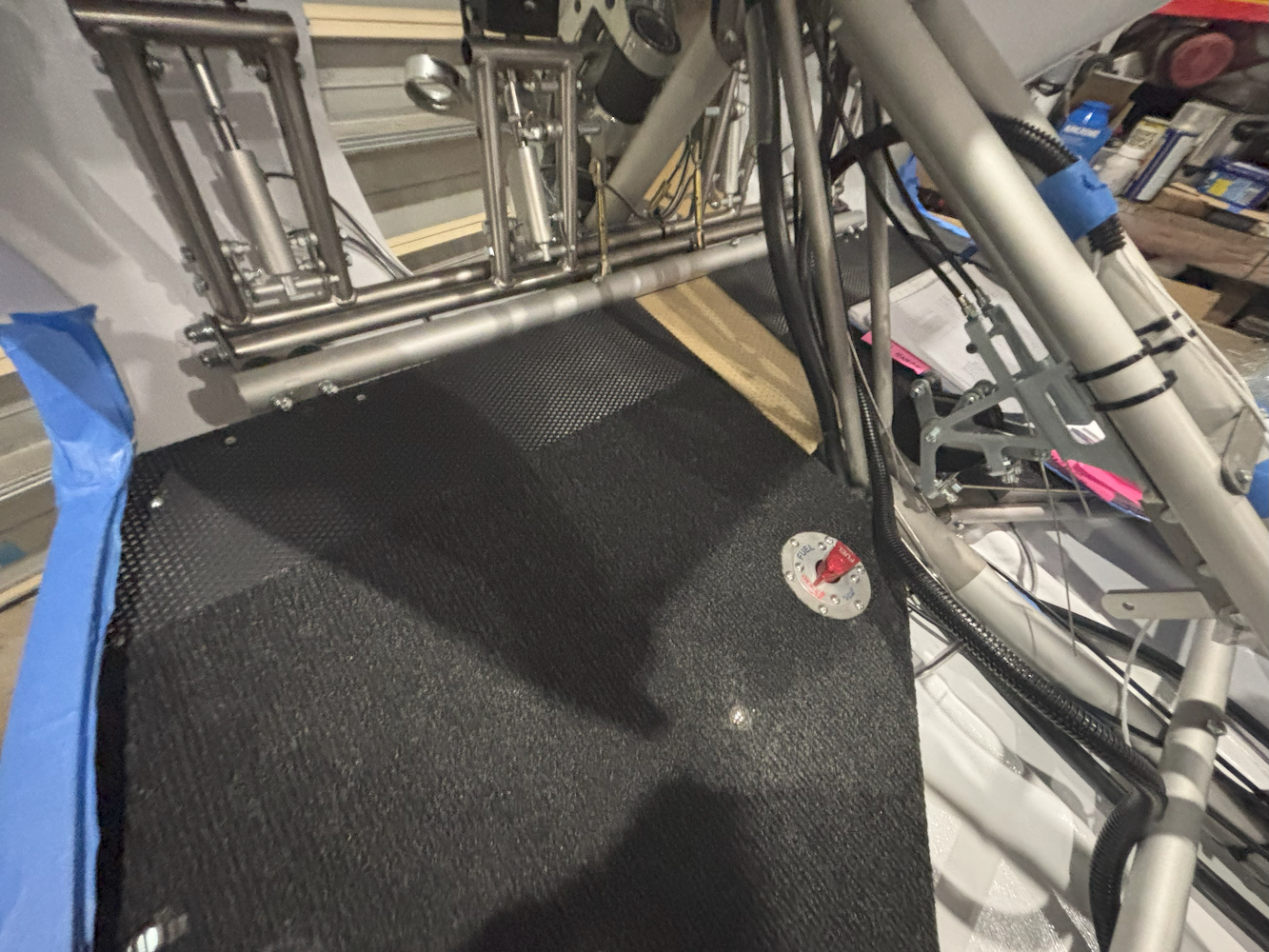

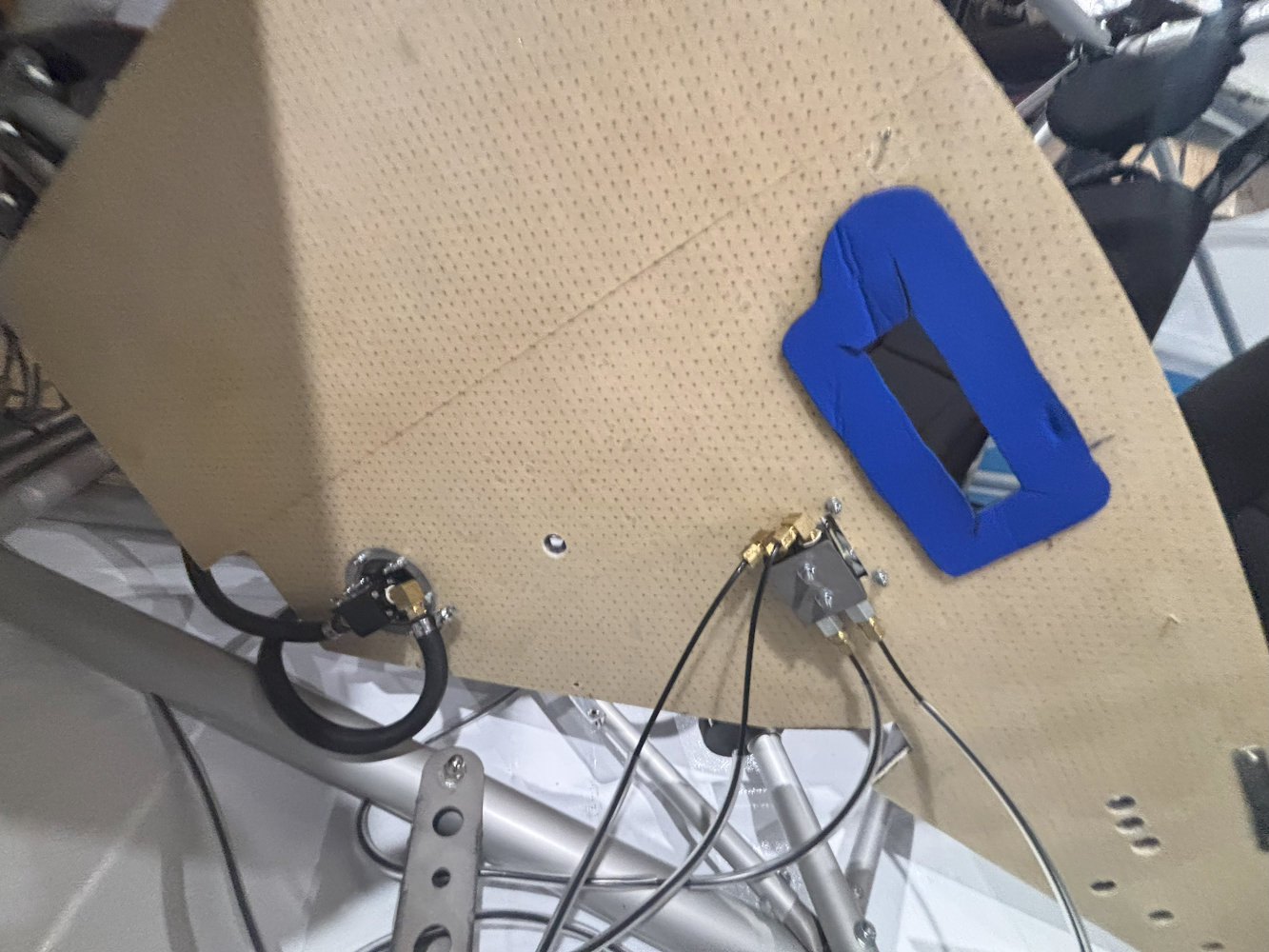

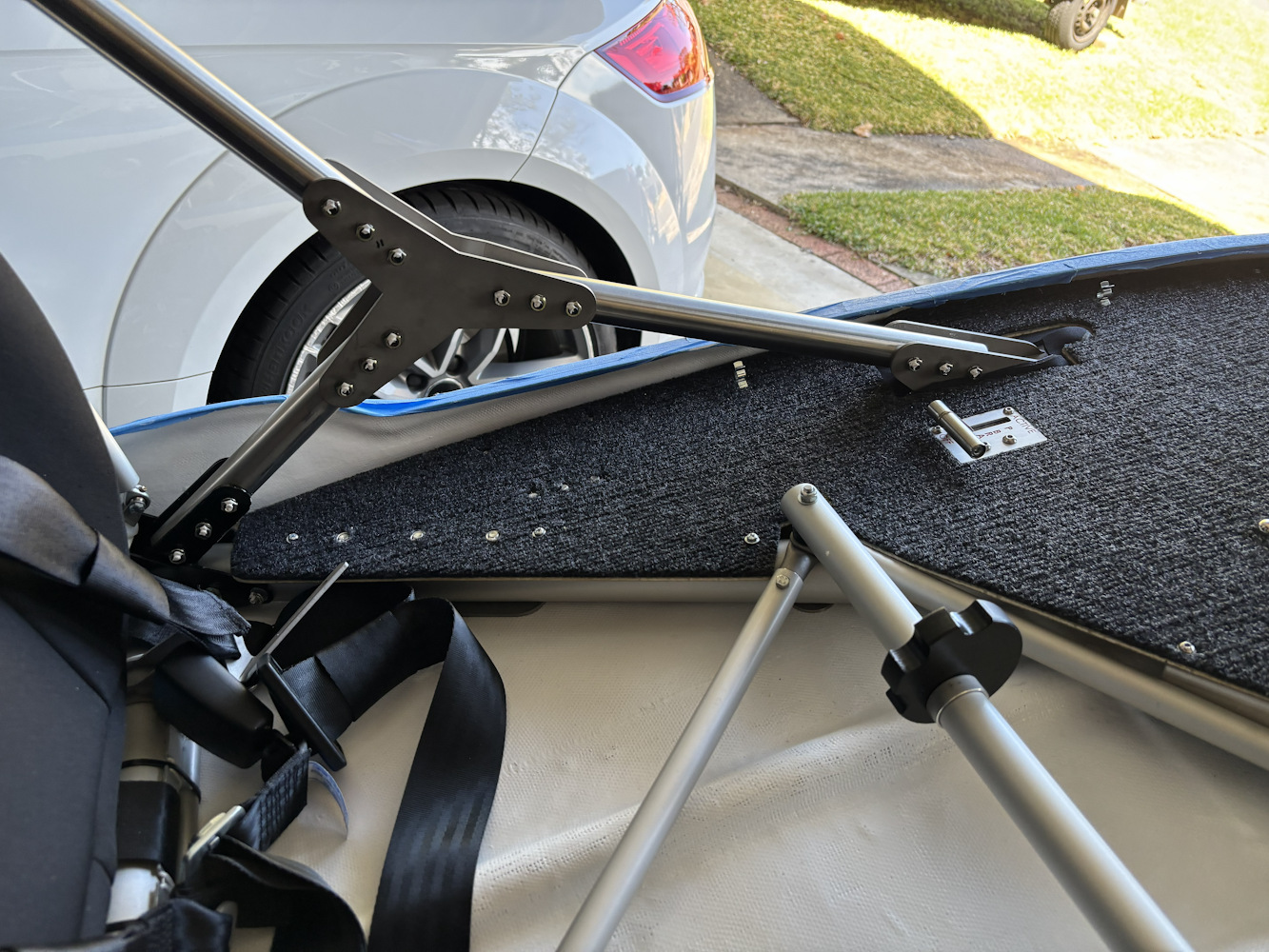

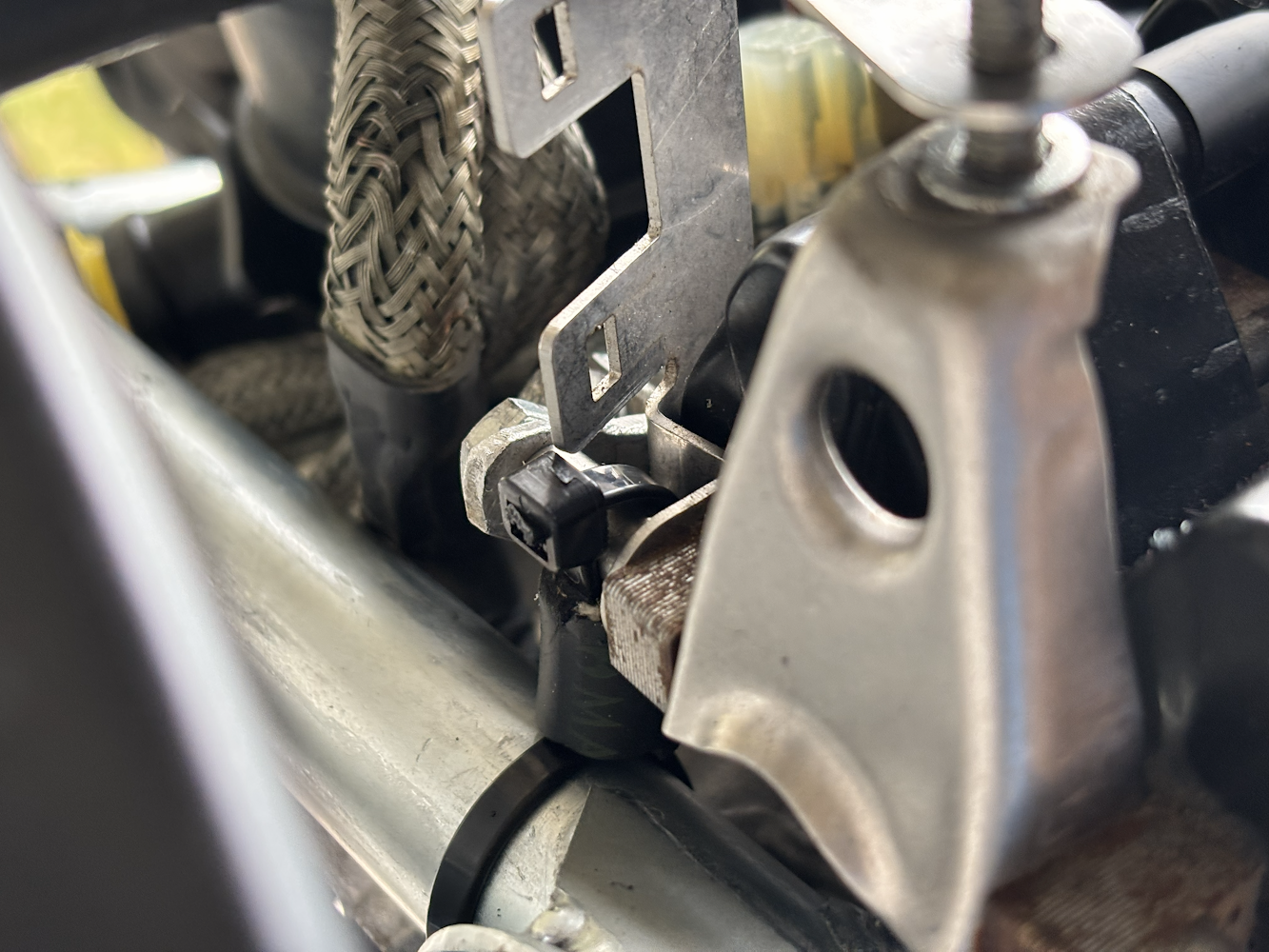

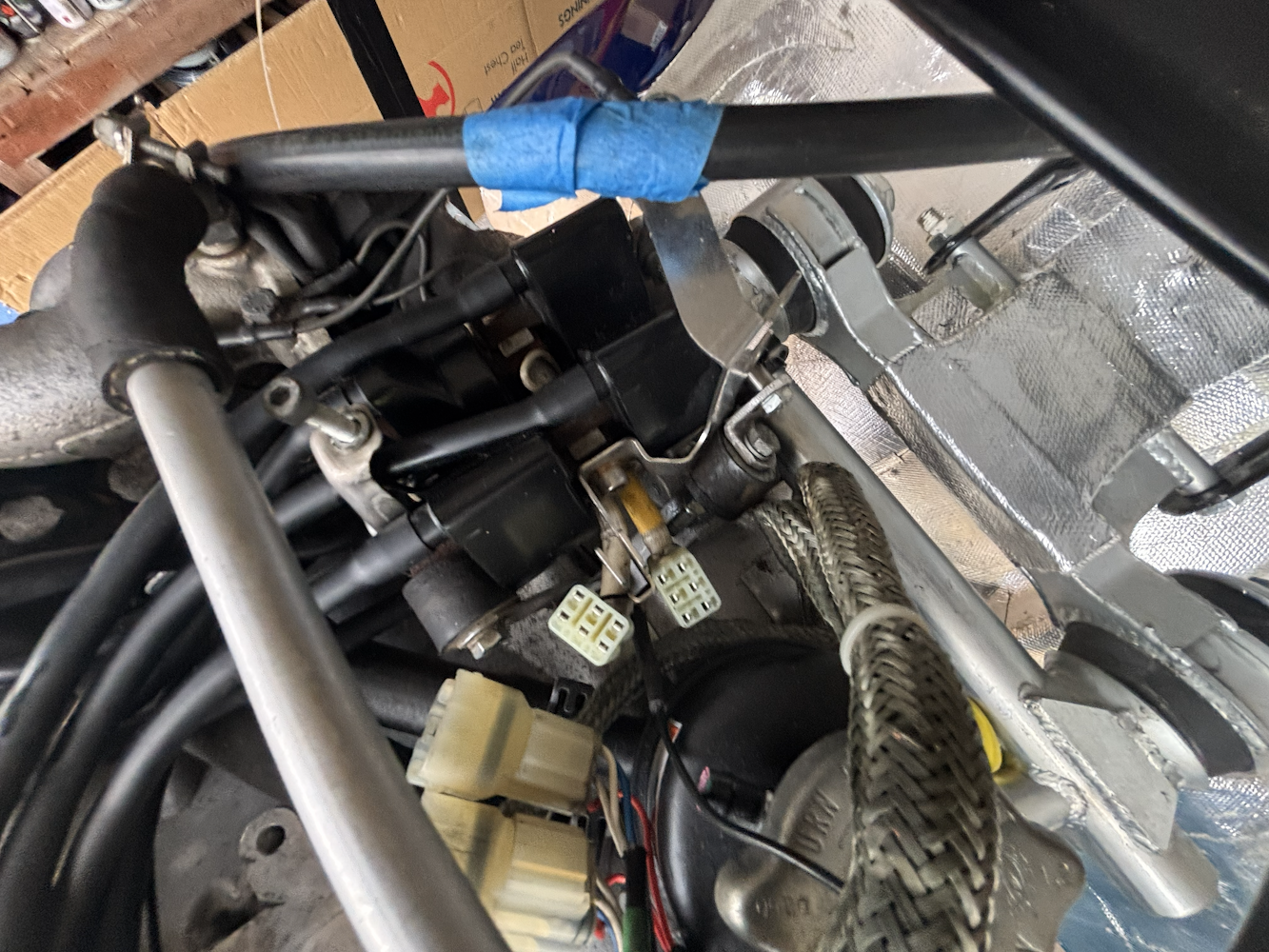

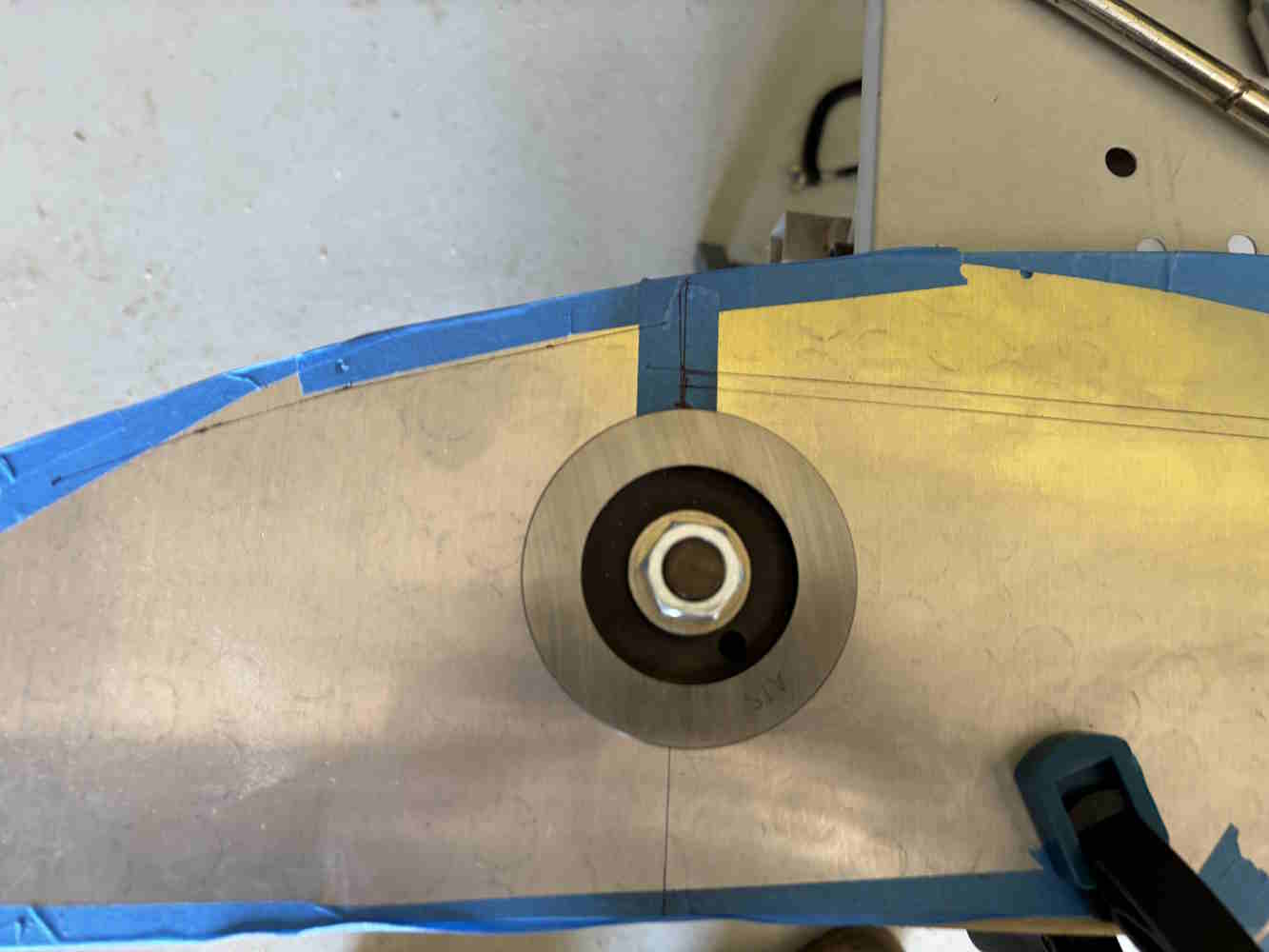

    Task: Assemble pulleys on bottom bracket.  More...
  • WING

    Aircraft: Bushcat 19-2226
    Task Date: 21/04/2025
    Builder: Malcolm Hardy
    Category: Wing
    Section: 65
    Hours: 2.5 hrs

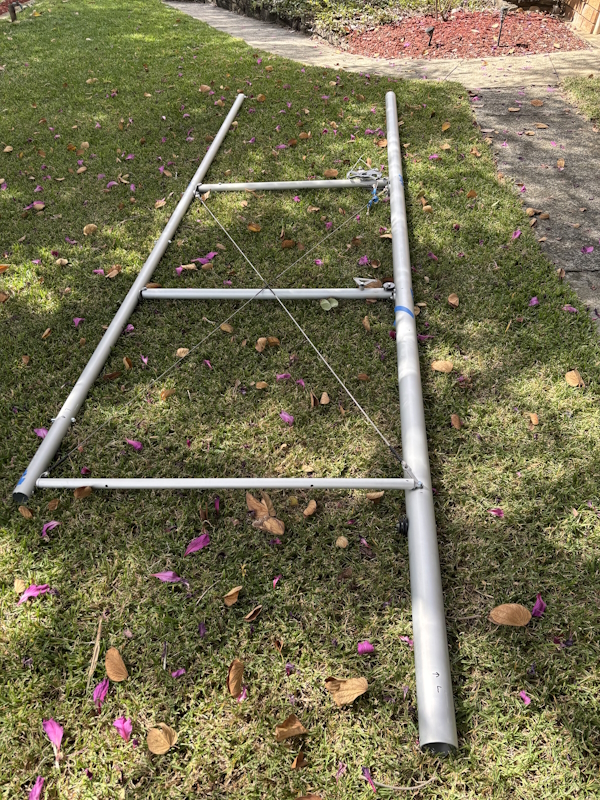

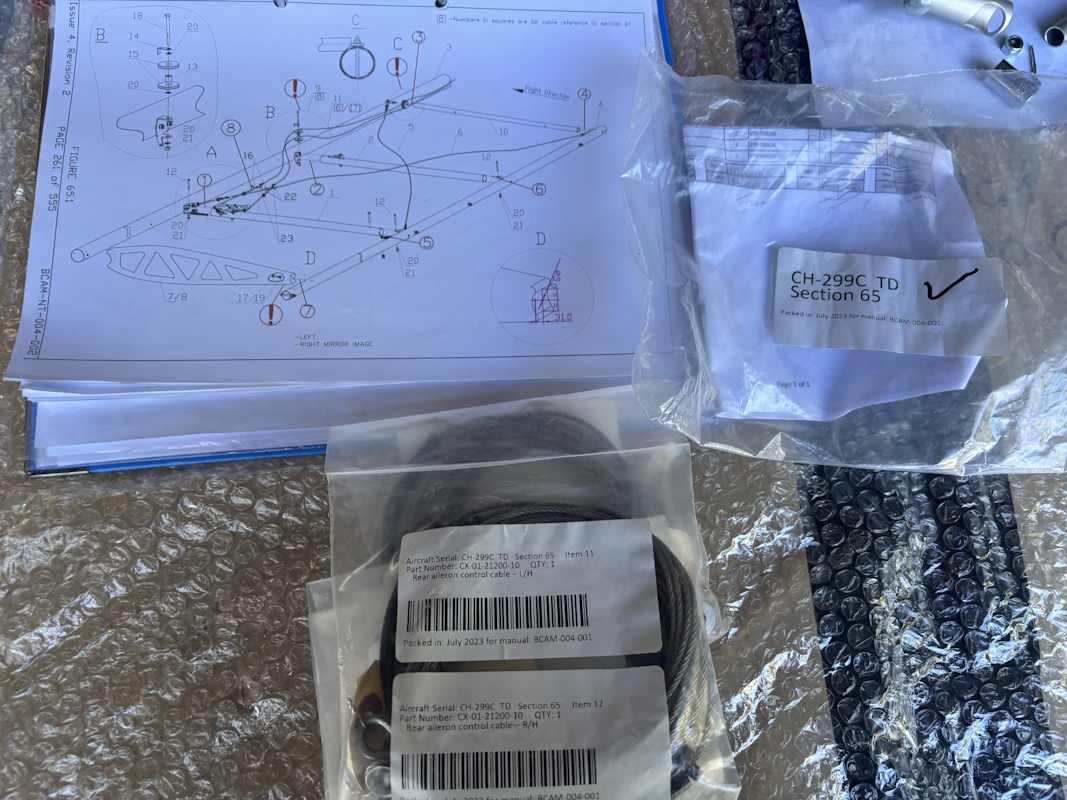

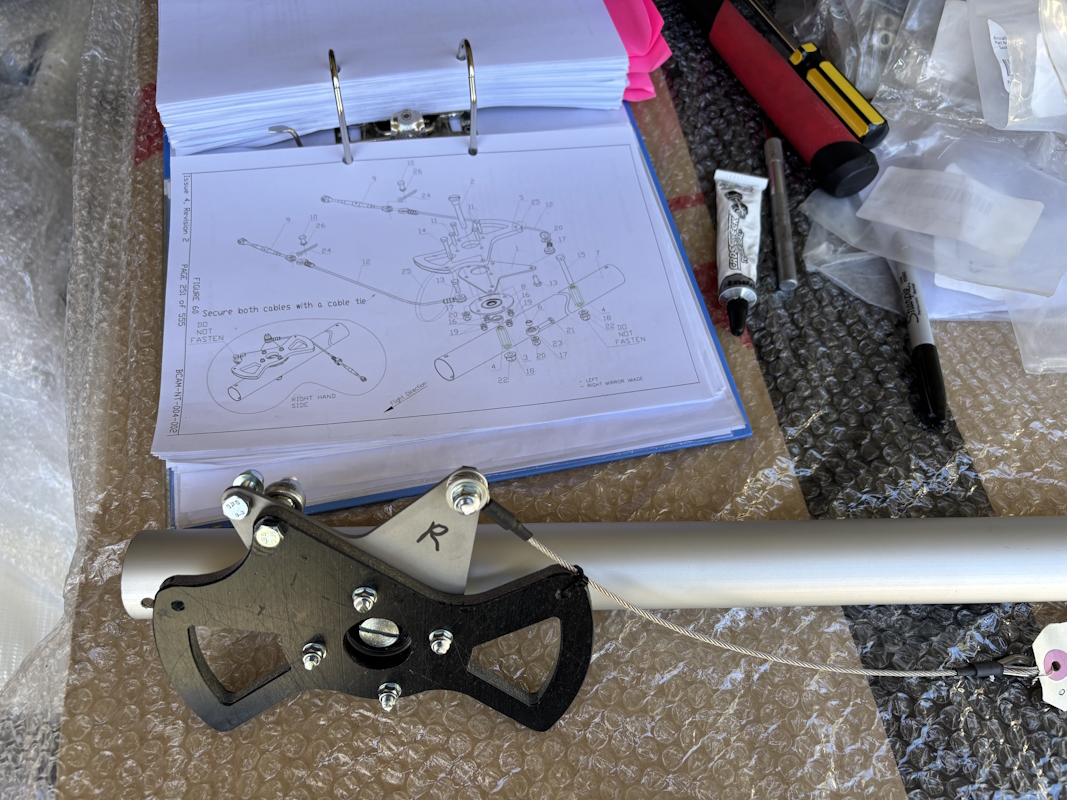

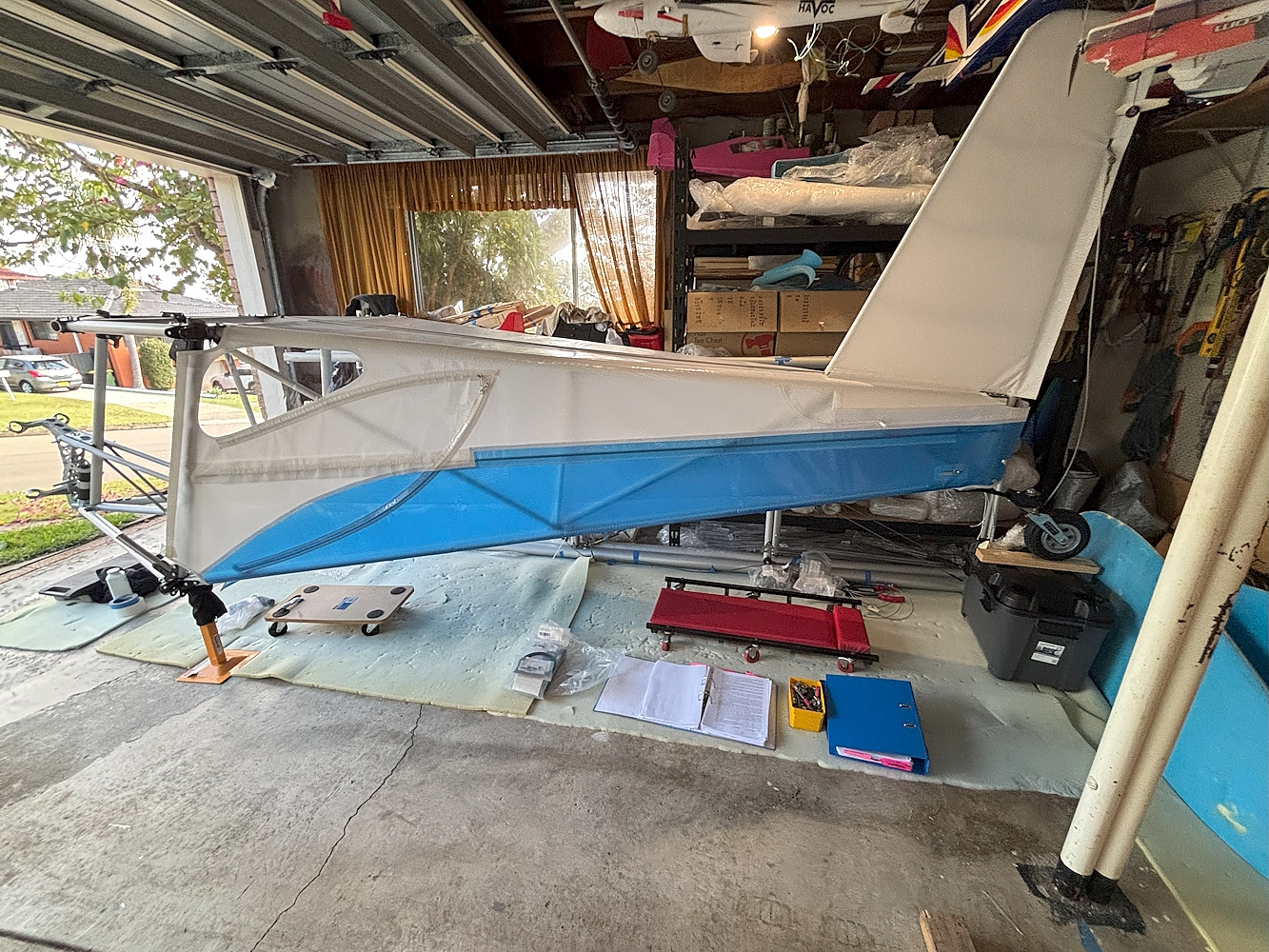

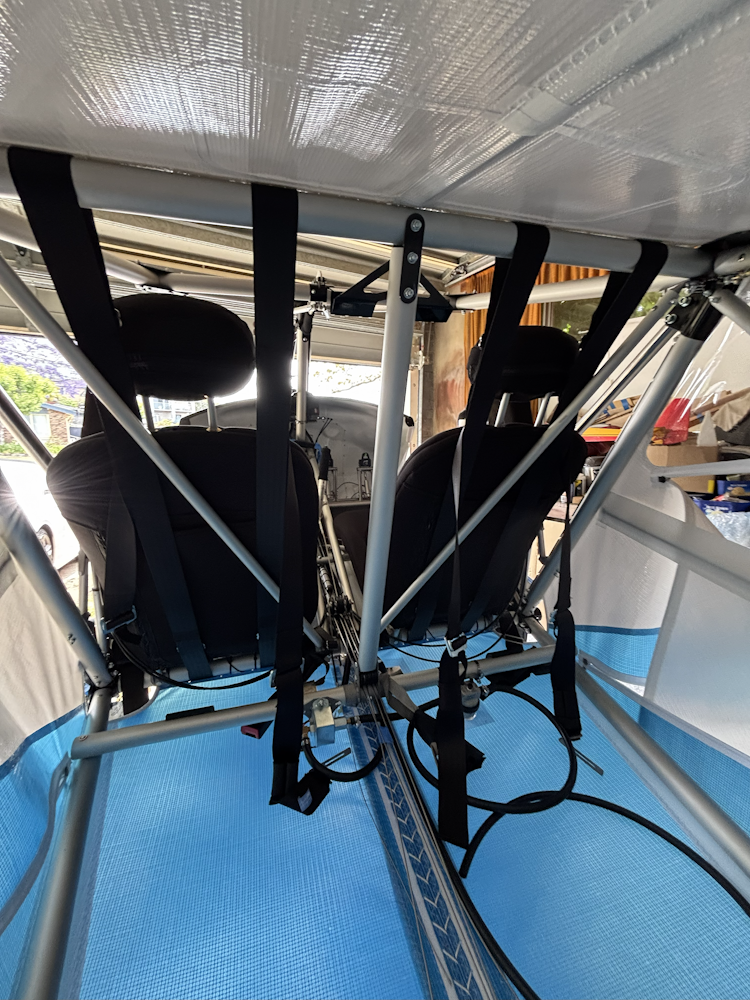

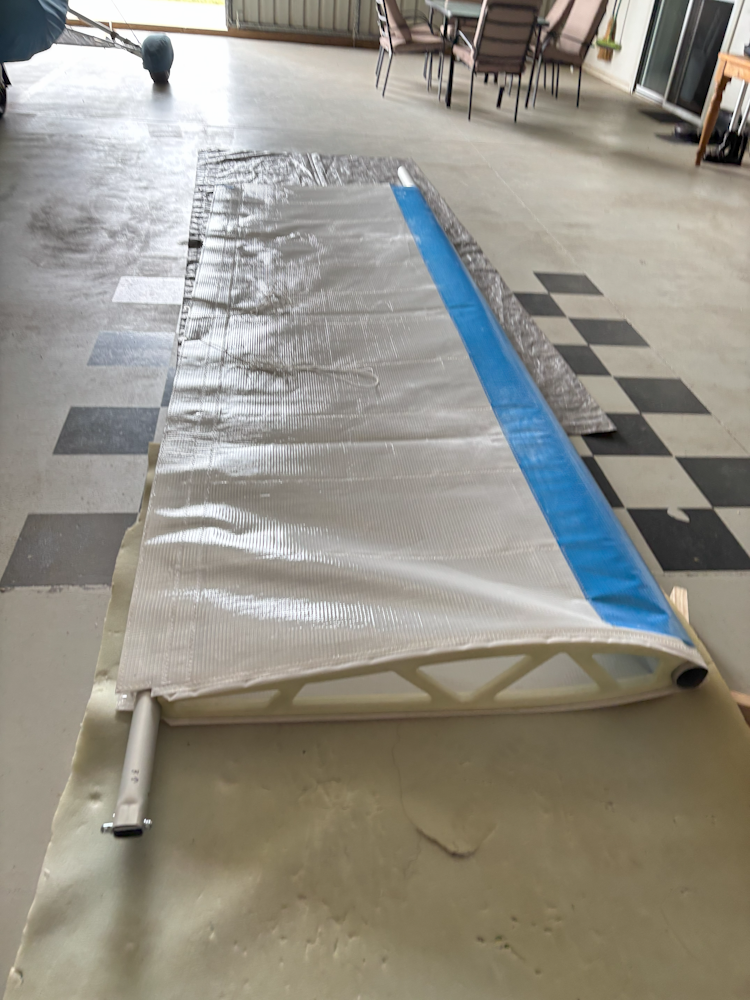

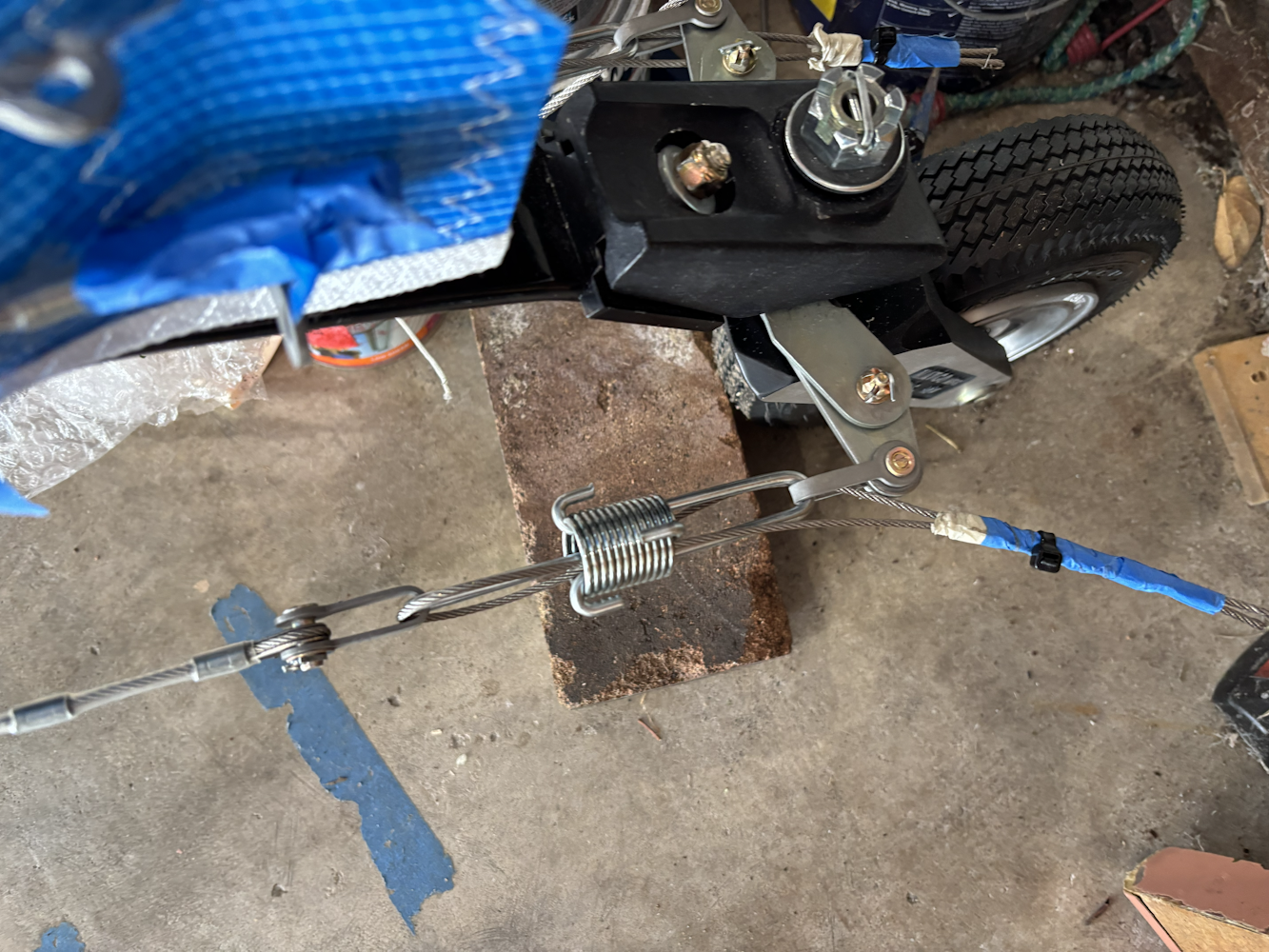

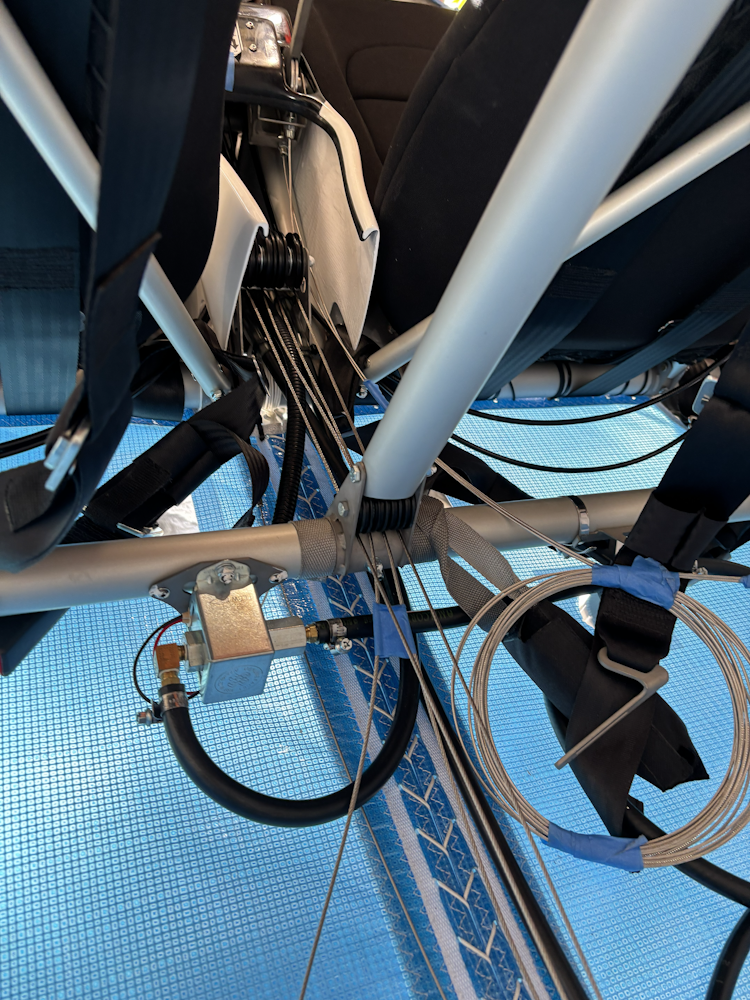

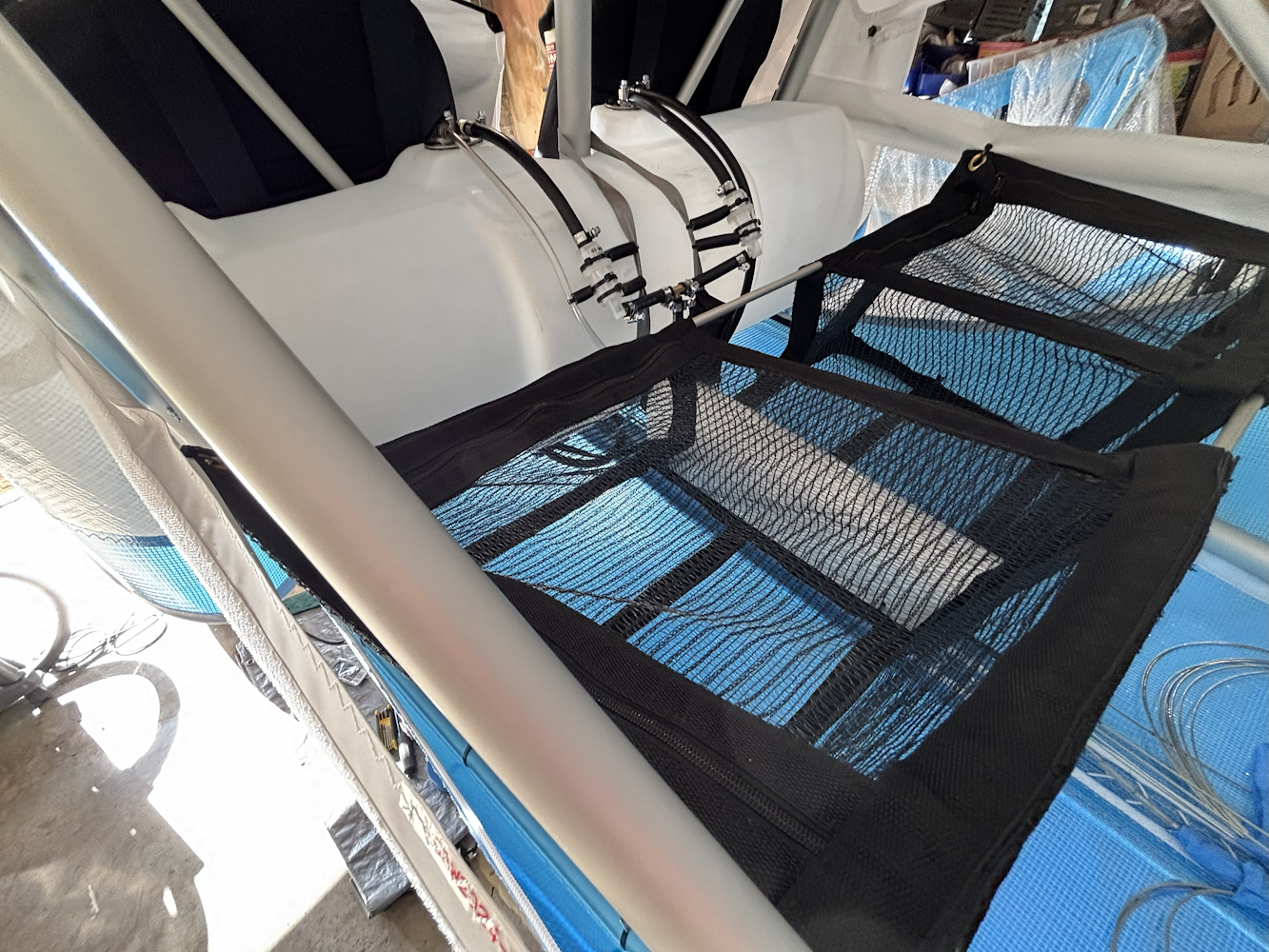

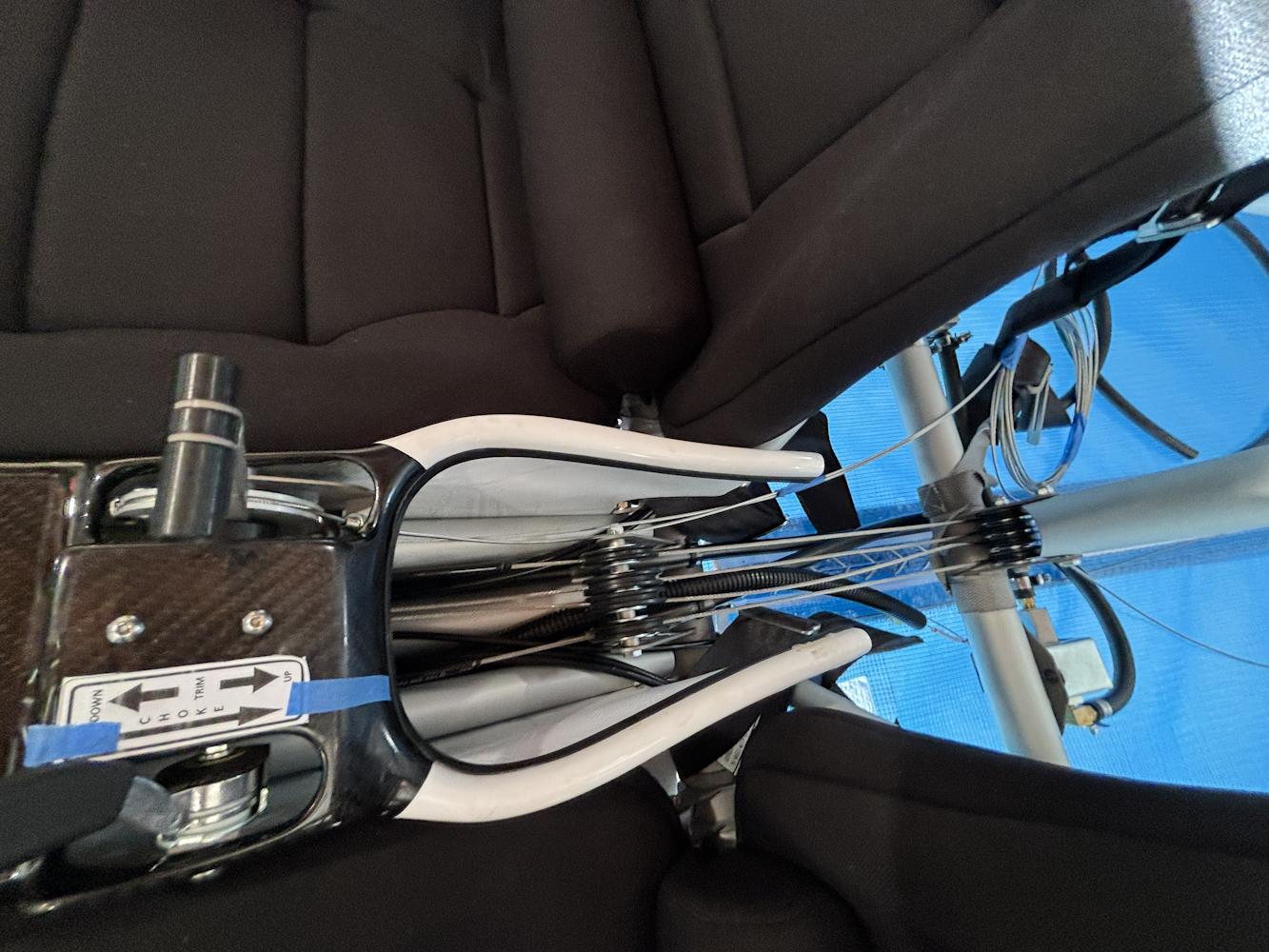

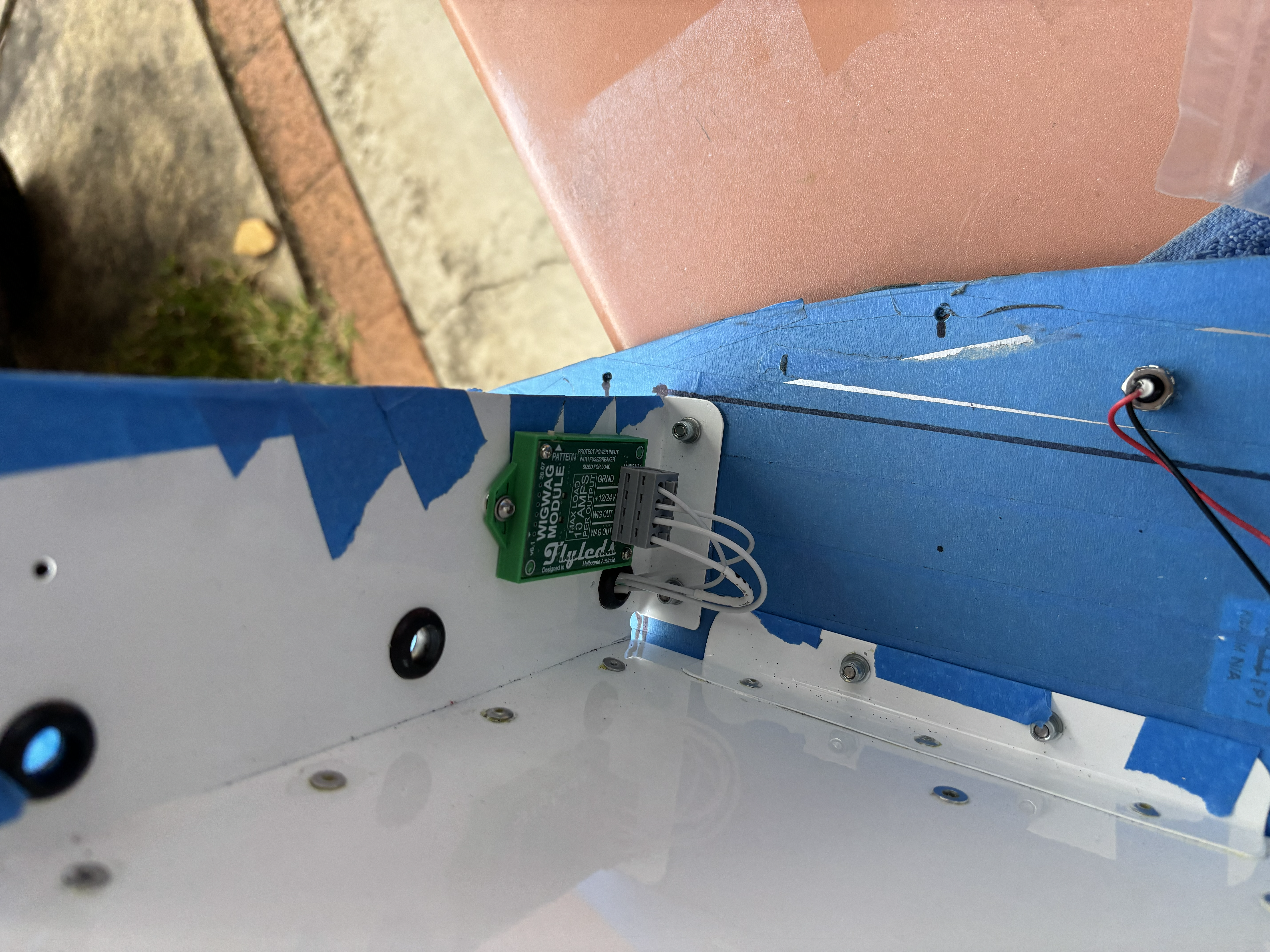

    Task: Assemble right wing section. Also installed Aileron control cable.  More...
  • WING

    Aircraft: Bushcat 19-2226
    Task Date: 20/04/2025
    Builder: Malcolm Hardy
    Category: Wing
    Section: 65
    Hours: 2.0 hrs

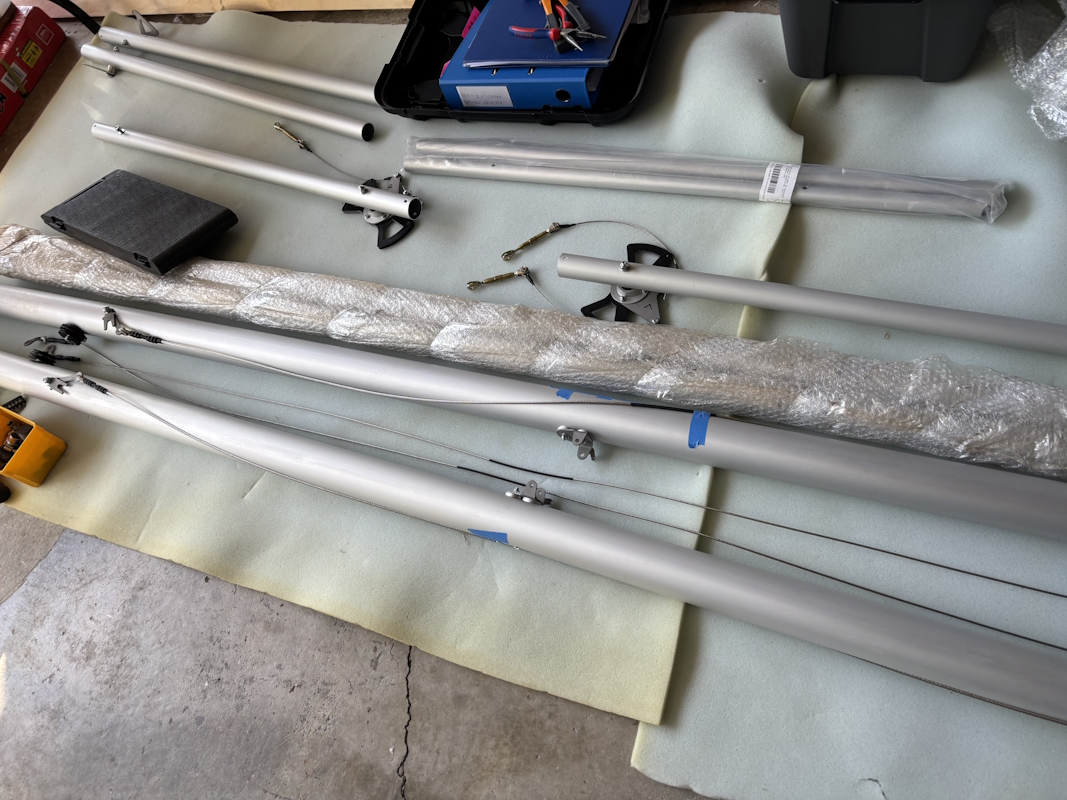

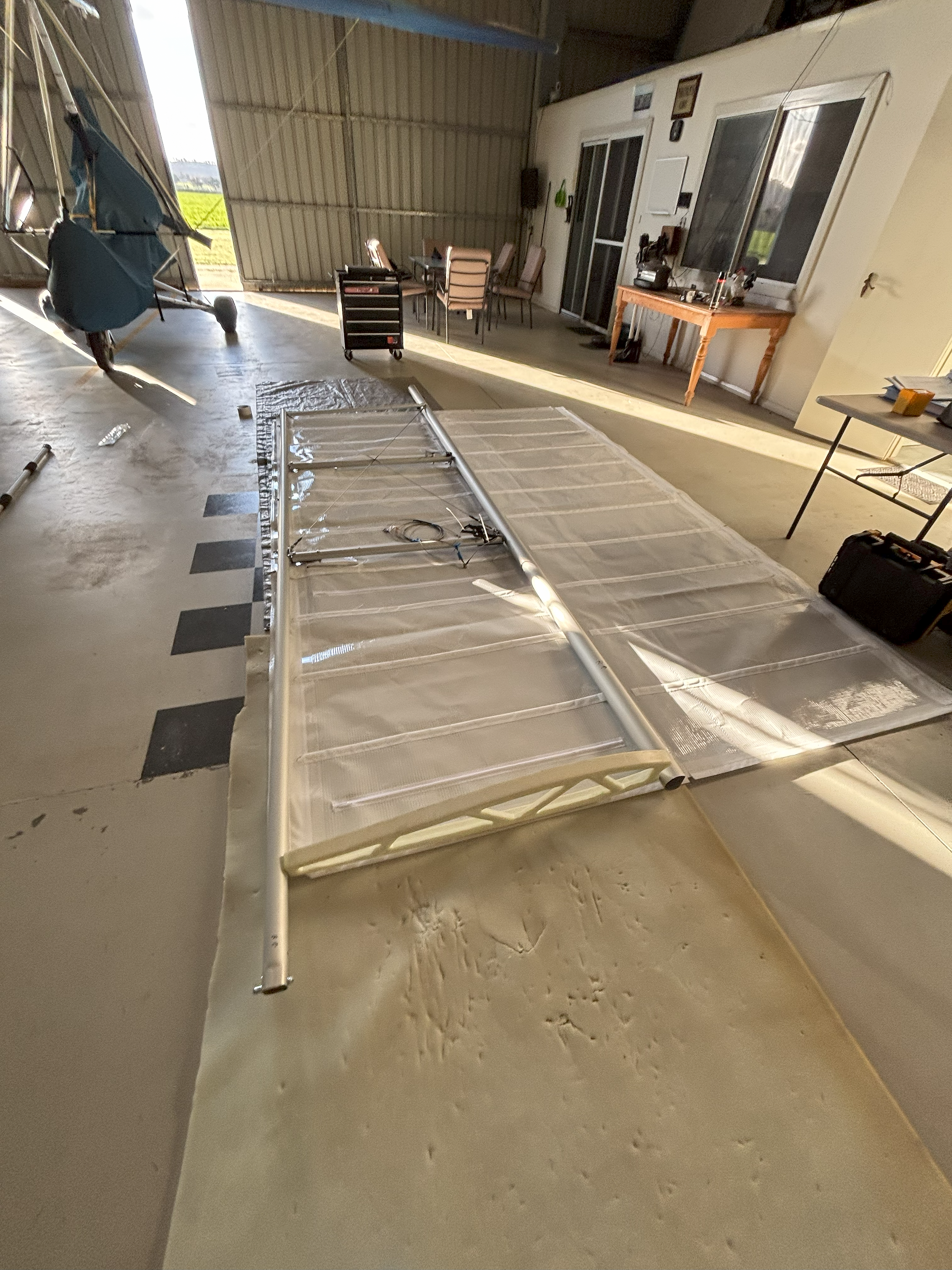

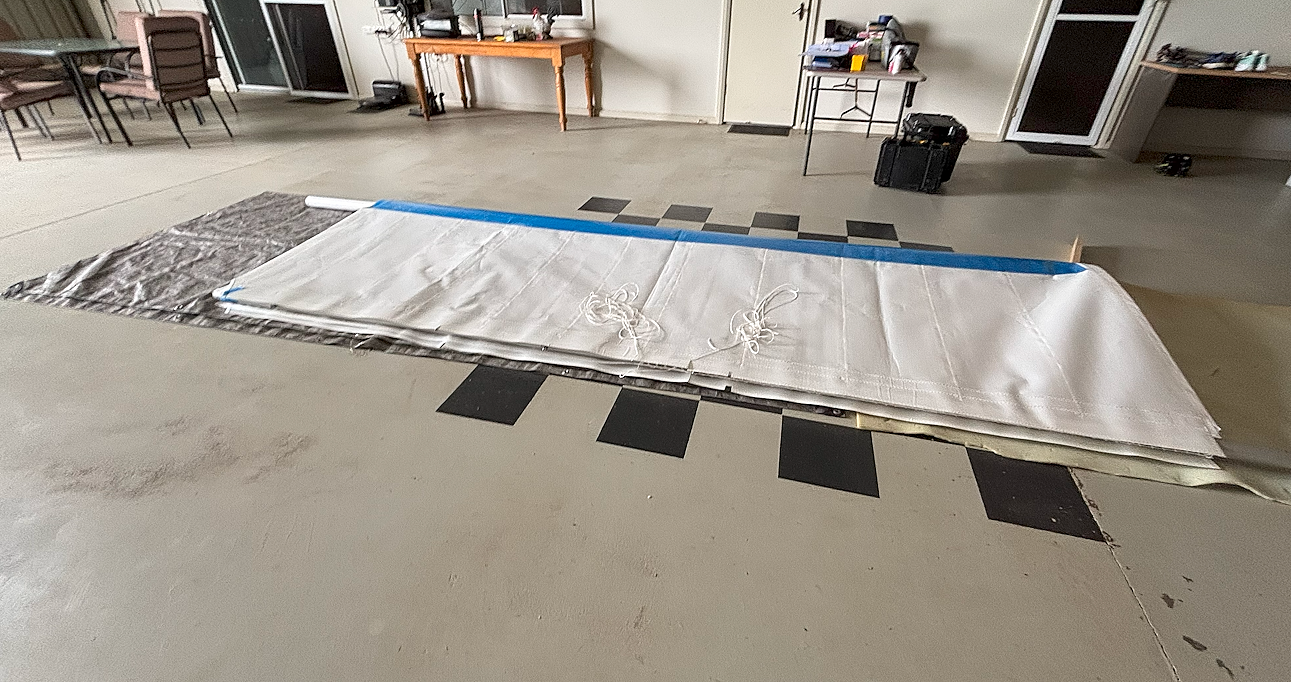

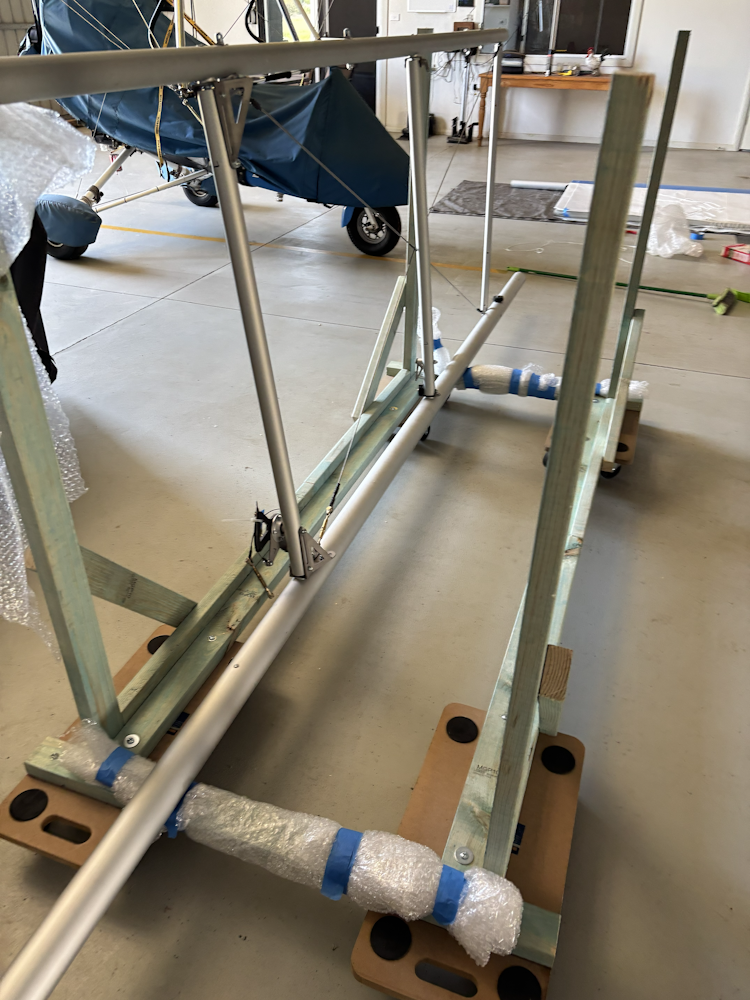

    Task: Assemble left wing section and prepare to assemble right wing section.  More...

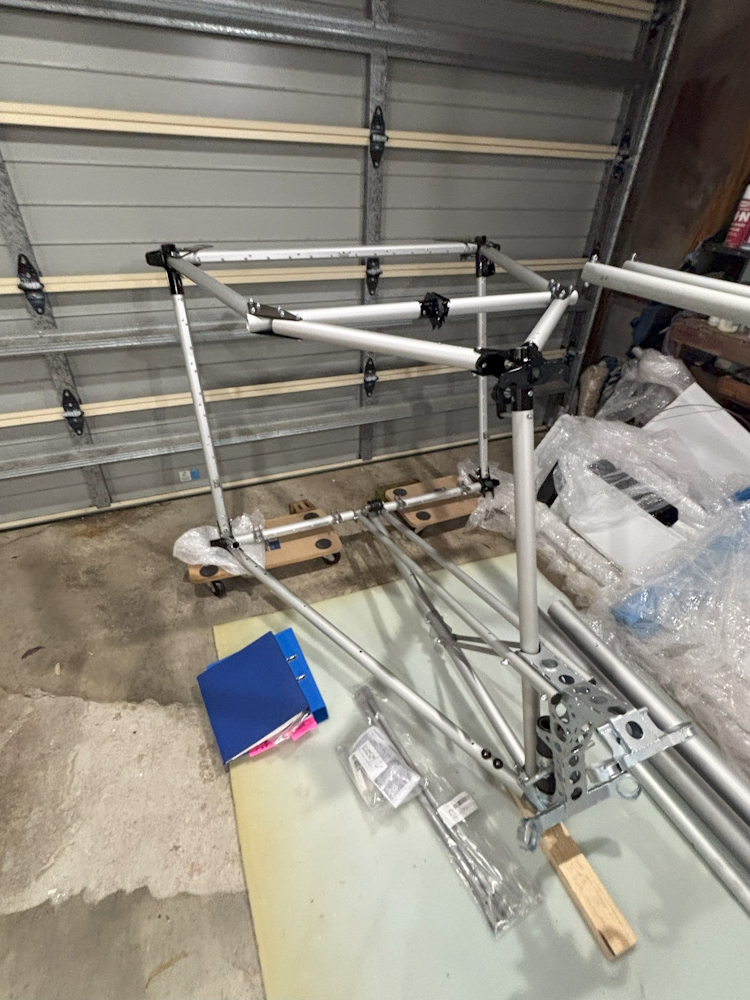

  • WING

    Aircraft: Bushcat 19-2226
    Task Date: 19/04/2025
    Builder: Malcolm Hardy
    Category: Wing

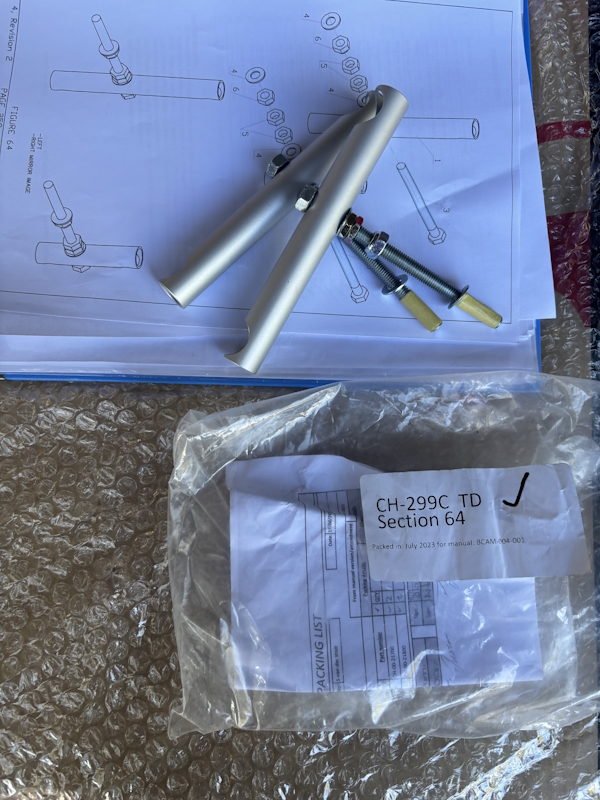

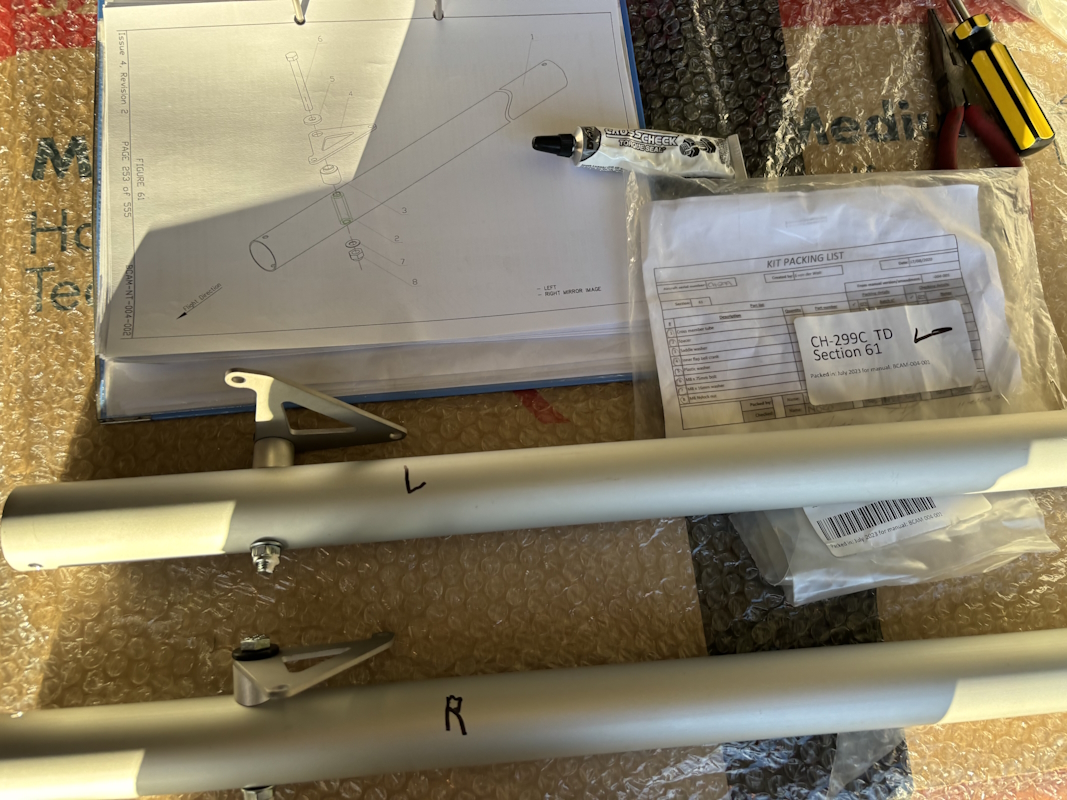

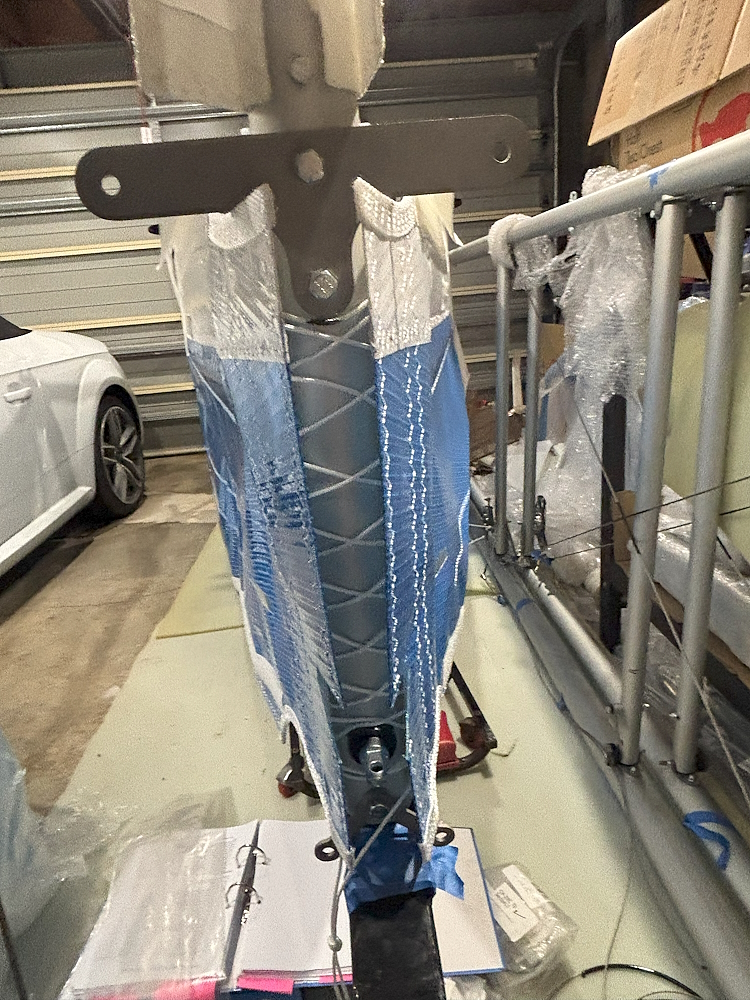

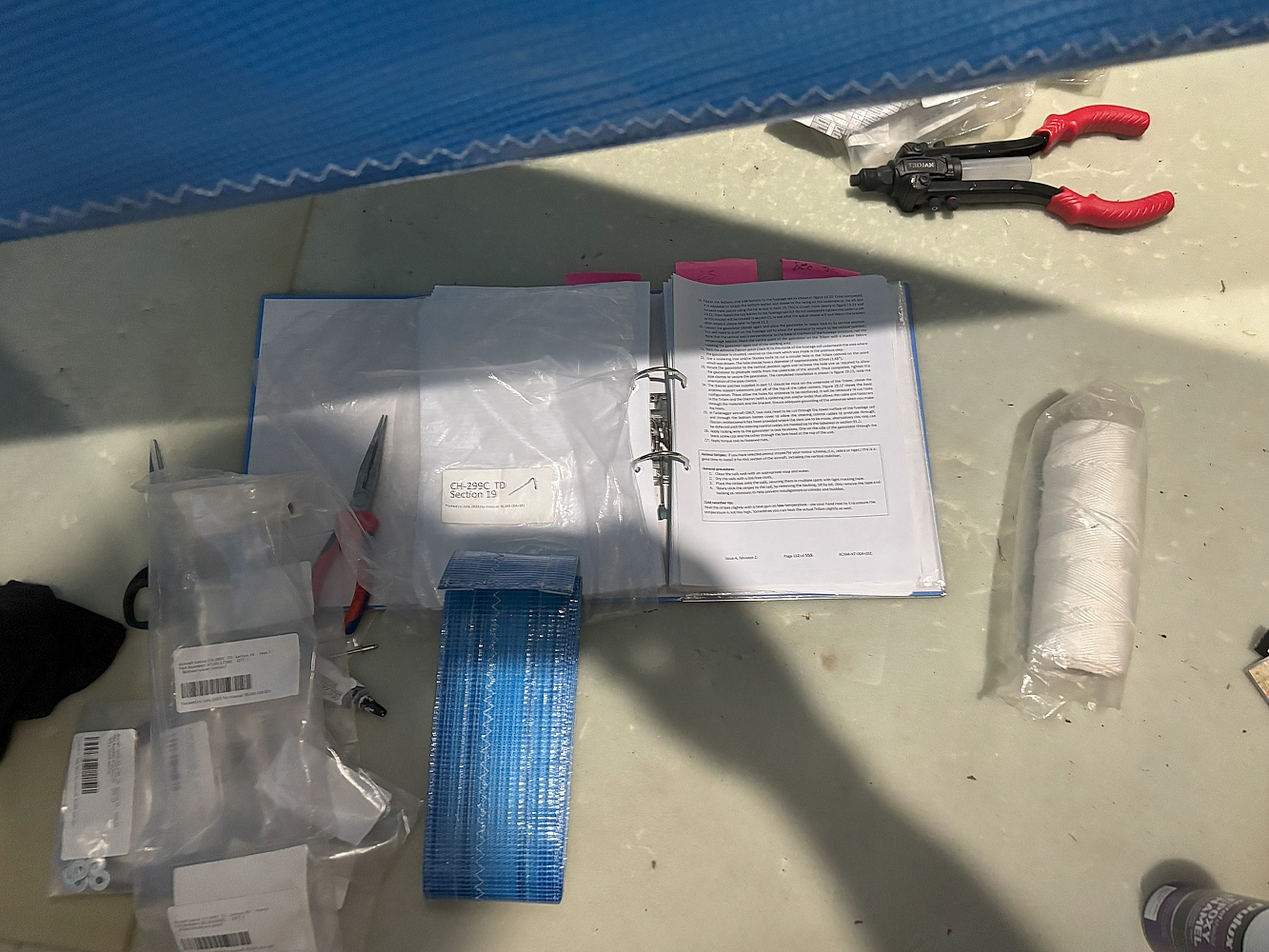

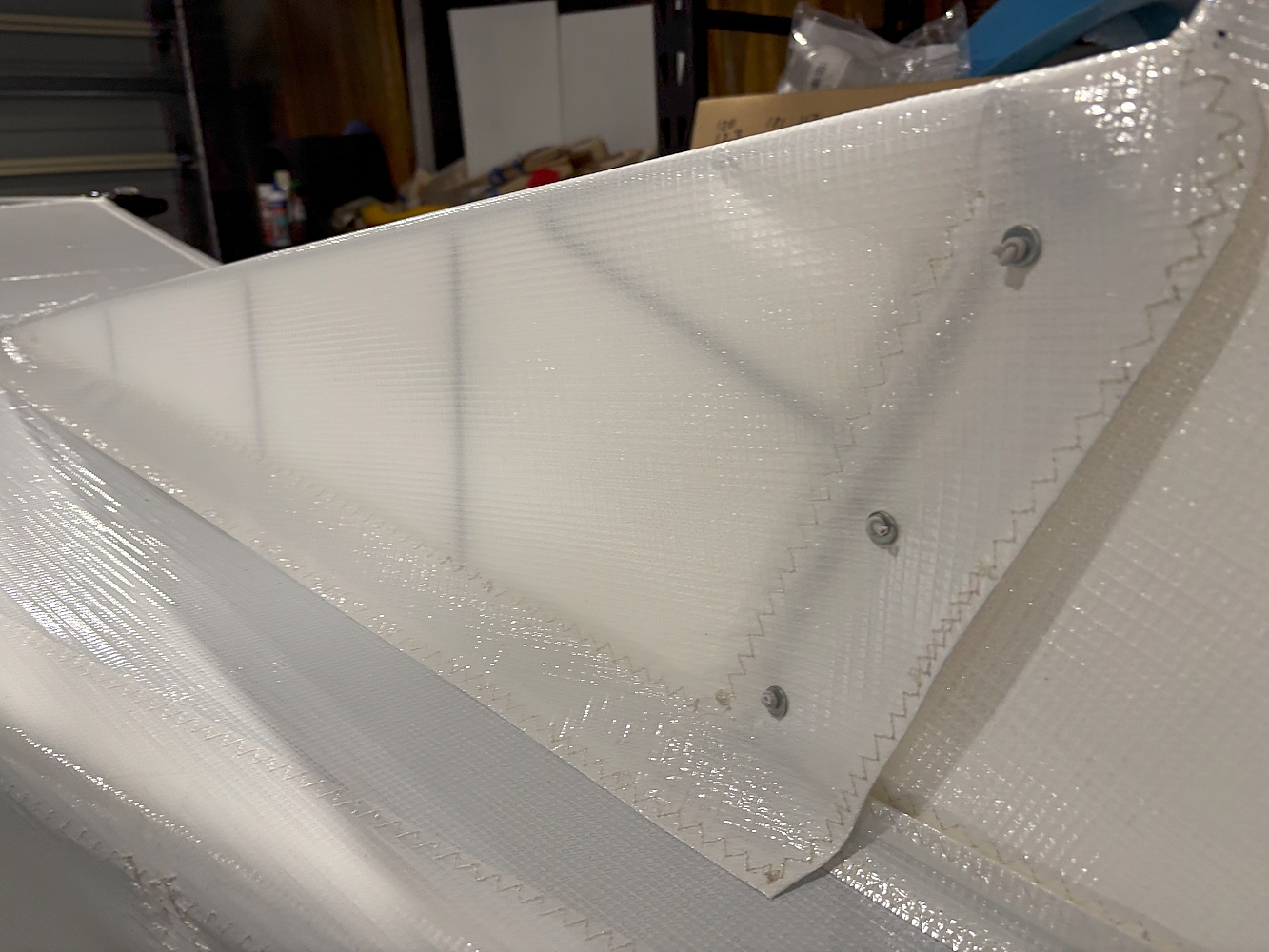

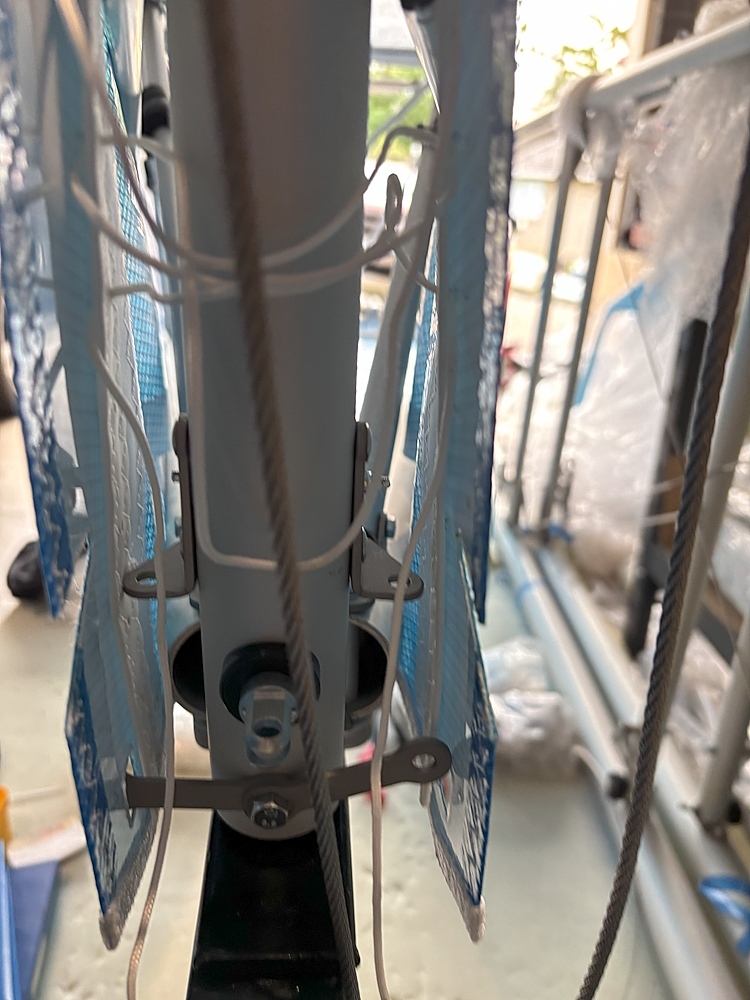

    Section: 62-64
    Hours: 4.5 hrs
    Task: Finish LE tube assembly. Build TE assembly for left and right wing sections. Found that incorrect TE jury strut fittings were supplied. Attached them temporarily and will follow up with Errol at GAP. …  More...
